GRP Swimming Pool Dubai: Benefits, Installation Process, and Cost Guide

GRP Swimming Pool

Standing on a half-finished villa plot in Al Barsha last summer, a homeowner asked a question we hear almost every week: “Why is everyone suddenly talking about GRP pools instead of the concrete pools my neighbours have?”

It is a fair question. For decades, concrete was the default choice for swimming pools across the UAE. Dubai’s climate, construction timelines, and homeowner expectations have changed, and so has the technology available to meet them.

A GRP swimming pool (Glass Reinforced Plastic, also known as a fiberglass pool) is a factory-manufactured pool shell that is craned into an excavated pit, backfilled, and connected to plumbing and filtration, often ready for water within days rather than months. This guide is written from direct, on-the-ground experience manufacturing and installing GRP structures across Dubai and the wider UAE.



What Is a GRP Swimming Pool?

GRP stands for Glass Reinforced Plastic, a composite material made by layering fine glass fibres within a polyester or vinyl ester resin matrix, then finishing the interior surface with a smooth, non-porous gelcoat. The result is a single, seamless pool shell that is engineered off-site in a controlled factory environment, then transported and installed as one complete unit.

Unlike a concrete pool, which is built layer by layer on the property, a GRP swimming pool arrives at the site already largely complete. Our own GRP (Glass Reinforced Plastic) product range is manufactured using exactly this process, under quality-controlled factory conditions rather than an open construction site.

Three facts define a GRP shell before it ever reaches a villa plot:

  1. It is manufactured, cured, and quality-tested entirely off-site.
  2. It arrives as one seamless structural unit, with no joints or grout lines.
  3. Its gelcoat surface is applied in the factory, not painted or plastered on site.

GRP vs Fiberglass vs Composite Pool: Clarifying the Terminology

One point that confuses many homeowners: GRP and “fiberglass pool” are the same thing. The terms are used interchangeably across the UAE and international markets:

  • GRP (Glass Reinforced Plastic): the technical, engineering term, commonly used in the Gulf and the UK.
  • Fiberglass pool: the more common consumer-facing term, especially in the US and Australia.
  • Composite pool shell: a broader industry term that also refers to GRP construction.

Whichever term a contractor uses, the underlying material science is identical: layers of glass fibre reinforcement bonded with resin, cured into a rigid, waterproof, one-piece structural shell. This is a different product from GRC (Glassfibre Reinforced Concrete), which uses a cement-based matrix instead of plastic resin and is typically used for architectural cladding, domes, and façade elements rather than pool basins.



Why Dubai Homeowners Are Increasingly Choosing GRP Swimming Pools

Having installed pools across villa communities from Arabian Ranches to Damac Hills, Jumeirah Islands to Al Barsha, we have watched demand shift noticeably toward GRP construction over the last few years. The reasons fall into three practical categories:

  • Climate and soil resilience specific to Dubai conditions.
  • Installation speed against tight handover deadlines.
  • Lower lifetime maintenance and chemical costs.

Built for Dubai’s Climate and Soil Conditions

Dubai’s combination of intense heat, high humidity, saline groundwater, and shifting sandy soil creates real engineering challenges for any in-ground structure.

  • Extreme heat resistance: a GRP shell’s gelcoat finish is engineered to withstand prolonged UV exposure and surface temperatures well above what is typical in temperate climates, without fading or chalking as quickly as painted concrete finishes.
  • Corrosion resistance: Dubai’s groundwater and coastal air carry high salt content. A GRP swimming pool has no exposed metal components in its structural shell, so it simply does not rust.
  • Ground movement tolerance: GRP has a degree of natural flexibility that rigid concrete lacks. In areas with soft or reactive sandy soil, this flexibility helps the shell absorb minor ground shifts without cracking.

Dramatically Faster Installation

This is often the single biggest factor for villa owners and developers working against handover deadlines.

  • A concrete pool typically takes 6 to 12 weeks from excavation to final handover.
  • A GRP swimming pool, because the shell arrives pre-manufactured, can often be installed and ready for water within 1 to 3 weeks, depending on site access, approvals, and equipment installation.
  • Manufacturing happens in parallel with municipal approvals, which compresses the overall project timeline further.

Lower Lifetime Maintenance Costs

The gelcoat surface of a GRP swimming pool is non-porous and smooth at a microscopic level, which matters more than it sounds.

  • Algae and bacteria need a porous surface to establish colonies; concrete and tiled surfaces, particularly at grout lines, offer far more surface area for organic growth.
  • Fewer algae blooms mean lower chemical consumption, with many GRP pool owners in the UAE reporting reduced chlorine and pH-balancing chemical usage.
  • No re-tiling, no re-grouting, no re-plastering. A well-installed GRP swimming pool shell is designed to retain its gelcoat integrity for 25 years or more with proper care.

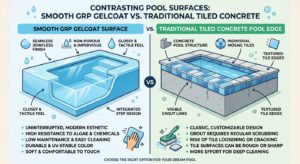

GRP swimming pool gelcoat surface compared with a traditional tiled concrete pool



Key Benefits of a GRP Swimming Pool

When clients ask us to justify the investment, these are the points that matter most in practice.

Structural and material benefits:

  • One-piece, seamless construction: no joints, no grout lines, no weak points where water can seep into the substructure.
  • High tensile strength relative to weight: the composite structure resists cracking under normal ground pressure far better than unreinforced masonry.
  • Corrosion-proof: zero risk of rebar rust bleeding through the surface, a common issue in older concrete pools across the UAE.
  • Consistent factory quality control: every shell is manufactured and pressure-tested under controlled conditions, unlike concrete cured outdoors in Dubai’s heat and dust.

Practical and lifestyle benefits:

  • Smooth, comfortable surface underfoot, with no rough plaster or abrasive tile grout.
  • Faster time to enjoyment, with swimming possible within weeks rather than months.
  • Lower ongoing chemical and cleaning costs, thanks to the non-porous surface.
  • Design flexibility, from classic rectangular lap pools to freeform lagoon designs and rooftop-suitable lightweight models.

Financial and value benefits:

  • Predictable, fixed-price installation, with far less exposure to cost overruns than concrete pools, where unexpected soil or water-table conditions can inflate the budget mid-project.
  • Lower total cost of ownership, since reduced chemical, maintenance, and resurfacing costs over 10 to 15 years frequently make GRP the more economical choice long-term.
  • Property value contribution, since a pool that looks pristine after a decade protects resale and rental value more effectively than one with cracked tiles and faded plaster. Our completed work on projects such as Desert Leisure Swimming Pools L.L.C. illustrates how a well-manufactured shell holds its finish over time.



GRP Swimming Pool vs Concrete Pool vs Vinyl Pool: Which Is Right for Your Dubai Property?

Every material has a place. Before the detailed comparison table, here is the short version:

  • Choose GRP for speed, lower maintenance, and rooftop or podium-level installations.
  • Choose concrete for fully bespoke architectural shapes and very large custom pools.
  • Choose vinyl only where the lowest possible upfront cost is the primary concern.
Factor GRP (Fiberglass) Pool Concrete Pool Vinyl Liner Pool
Installation time 1–3 weeks 6–12+ weeks 3–5 weeks
Customization Good, many standard and semi-custom moulds Excellent, fully bespoke shapes, depths, and features Limited to standard liner shapes
Surface texture Smooth, non-porous gelcoat Rougher plaster or tile texture Smooth, but liner can wrinkle over time
Maintenance & chemical use Lower Higher (porous surface, grout lines) Moderate
Long-term durability 25+ years with proper care 20–30+ years but needs periodic resurfacing/re-tiling 7–15 years before liner replacement
Weight (structural load) Lightweight, suitable for rooftops/podiums Heavy, requires substantial foundation Lightweight
Repair complexity Specialized gelcoat/laminate repair Widely available concrete/tile repair Liner patching or full replacement
Best suited for Villas, rooftop pools, fast-turnaround projects Large custom villas, infinity edges, complex geometry Lowest upfront cost projects

Our honest take: if the priority is a highly bespoke architectural statement pool with an infinity edge, concrete remains the more flexible medium. If the priority is speed, lower lifetime maintenance, and structural reliability against Dubai’s soil and salt conditions, a GRP swimming pool is very hard to beat, and for rooftop or weight-restricted sites, it is often the only realistic option.

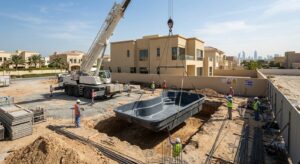

Crane lowering a GRP swimming pool shell into a Dubai villa excavation site



The GRP Swimming Pool Installation Process in Dubai: Step by Step

This is where experience really shows. A GRP installation looks simple from the outside, but there are technical decisions along the way that determine whether a pool lasts 25 trouble-free years or develops problems within its first Dubai summer. The full journey covers nine stages:

  1. Site survey, design, and feasibility assessment
  2. Approvals and NOC processing
  3. Manufacturing the shell off-site
  4. Excavation
  5. Shell delivery and crane placement
  6. Backfilling
  7. Plumbing, filtration, and equipment installation
  8. Decking, coping, and landscaping integration
  9. Water testing, balancing, and final handover

Step 1: Site Survey, Design, and Feasibility Assessment

Before anything is manufactured, an experienced contractor visits the site to assess:

  • Access constraints, since narrow side access or overhead cabling needs careful crane-path planning before the shell is even manufactured.
  • Soil type and water table depth, as sandy soil with a high water table requires specific drainage and hydrostatic relief planning.
  • Structural loading, for rooftop or podium pools, confirmed by a structural engineer before manufacturing begins.
  • Design intent, covering shape, depth, step configuration, and integrated features such as spa jets, tanning ledges, and lighting.

Step 2: Approvals – Dubai Municipality, Developer NOC, and Civil Defence

This step is frequently underestimated, and it is one of the most important parts of any legitimate installation.

  • Dubai Municipality approval is required for most residential pool installations, covering structural drawings, plumbing layout, and safety compliance.
  • Properties inside master-planned communities (Emaar, Damac, Nakheel, Sobha, and similar developers) also need a developer NOC, since community design guidelines apply on top of municipal codes.
  • Civil Defence approval may apply for commercial, hotel, or large-scale residential developments.

A reputable GRP swimming pool contractor manages this documentation on the client’s behalf, but it is worth confirming upfront exactly which approvals a specific plot and community require.

Step 3: Manufacturing the GRP Shell (Off-Site, in Parallel)

While approvals progress, the shell itself is manufactured in a controlled factory environment through the following stages:

  • Mould preparation, where the interior mould is cleaned and coated with a release agent.
  • Gelcoat application, applied first to become the pool’s smooth, coloured interior surface once demoulded.
  • Laminate build-up, where successive layers of glass fibre matting and resin are applied by hand lay-up or spray-up technique to reach engineered structural thickness.
  • Reinforcement of high-stress zones, such as steps, benches, and corners.
  • Curing, quality control, and demoulding, including thickness checks and structural testing before release from the mould.

This is exactly the process our GRP manufacturing and installation services follow for every pool shell produced in-house.

Step 4: Excavation

Once approvals are secured, on-site excavation begins.

  • Excavation dimensions are cut slightly larger than the shell to allow for a compacted sand or granular backfill bed.
  • A level, compacted base layer is prepared at the bottom of the excavation, since an uneven base is one of the most common causes of shell stress cracking after installation.
  • Groundwater management, or dewatering, may be required where excavation intersects the water table.

Step 5: Shell Delivery and Crane Placement

This is the most visually dramatic, and technically precise, stage of the entire process.

  • The GRP shell is transported to site on a flatbed trailer, protected against transit stress.
  • A mobile crane lifts the shell using engineered lifting points and lowers it into the prepared excavation.
  • The shell is checked for level, alignment, and orientation against the design drawings before any backfilling begins.
  • Temporary bracing holds the shell in position during the backfill stage.

Step 6: Backfilling

Backfilling must happen simultaneously with pool filling, not before or after, which is a critical technical point inexperienced installers sometimes get wrong.

  • Water is introduced into the shell gradually.
  • Backfill material, typically a sand-cement slurry or compacted granular fill, is placed around the shell in stages that match the rising water level.
  • This synchronized approach balances internal water pressure against external backfill pressure, preventing shell distortion or cracking.

Step 7: Plumbing, Filtration, and Equipment Installation

With the shell secured, mechanical systems are connected.

  • Filtration system: sand, cartridge, or DE filters sized to the pool’s volume and Dubai’s higher bather-load and evaporation conditions.
  • Circulation pumps: selected for energy efficiency, since pumps run for extended hours daily in the UAE climate.
  • Heating and cooling: many Dubai villa pools now include pool cooling systems, since ambient pool water can become uncomfortably warm during peak summer.
  • Sanitization systems: chlorine, saltwater chlorination, or UV/ozone options, selected based on owner preference.
  • Lighting, jets, and automation: LED lighting, spa jets, and smart controls are increasingly standard requests.

Step 8: Decking, Coping, and Landscaping Integration

The pool structure itself is only part of the finished result.

  • Coping: the edge treatment where the pool meets the deck, typically in natural stone, porcelain, or travertine.
  • Decking: surrounding hardscape designed to handle direct sun exposure without becoming uncomfortably hot underfoot.
  • Landscaping integration: planting, shade structures, and outdoor living space design tying the pool into the broader garden or terrace layout.

Step 9: Water Testing, Balancing, and Final Handover

Before handover, a thorough quality process should always include:

  • Water chemistry balancing, bringing pH, alkalinity, and sanitizer levels into a safe, comfortable range.
  • Equipment function testing for pumps, filtration, heating/cooling, lighting, and automation under real operating conditions.
  • Leak and pressure testing of plumbing lines before the deck and landscaping fully conceal them.
  • Safety inspection covering fencing, non-slip surfaces, and depth markers.
  • Client walkthrough and documentation handover, including warranty information and maintenance guidelines.

From site survey to final handover, a well-run GRP swimming pool project in Dubai typically completes in 3 to 6 weeks total.

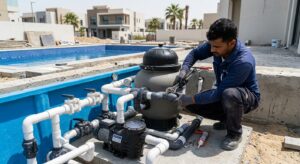

Technician installing filtration equipment for a GRP swimming pool in Dubai



GRP Swimming Pool Cost in Dubai: A Realistic Budget Guide

Cost is, understandably, the question every client asks first. Three points frame the honest answer before the numbers:

  • There is no single fixed government price list for pool construction in Dubai.
  • Every figure below is a market-based estimate, not a guaranteed quote.
  • Final pricing always depends on site assessment, chosen finishes, and equipment specification.

Indicative Cost Ranges by Pool Type

Pool Type Typical Starting Cost Typical Full Range Best Suited For
Small plunge / splash GRP pool AED 50,000+ AED 50,000 – 100,000 Compact villa gardens, apartments with terrace space
Standard residential GRP swimming pool (6m x 3–4m) AED 60,000+ AED 60,000 – 130,000 Family villas, straightforward rectangular or freeform designs
Mid-size GRP pool with added features AED 90,000+ AED 90,000 – 180,000 Larger villas wanting spa jets, LED lighting, tanning ledges
Large or custom GRP pool AED 150,000+ AED 150,000 – 250,000+ Extended families, entertainment-focused villas
Rooftop / podium GRP pool Varies significantly Depends on structural engineering and crane logistics High-rise residences, townhouses, podium developments
Commercial GRP pool AED 250,000+ AED 250,000 – 1,000,000+ Hotels, community clubhouses, resort developments



What Actually Drives the Final Price of a GRP Swimming Pool

When two quotations for what looks like “the same pool” differ by tens of thousands of dirhams, it almost always comes down to these factors:

  • Size and depth, since larger volume means more material, excavation, backfill, and larger filtration equipment.
  • Shape complexity, as standard moulds are more cost-effective than fully custom shapes with multiple curves or integrated spas.
  • Site access and logistics, since restricted access can require a larger crane class or special routing.
  • Ground conditions, as a high water table or unstable soil adds dewatering or stabilization costs.
  • Equipment specification, ranging from basic filtration to full packages with heating, cooling, and smart automation.
  • Finishes, including coping, decking materials, and landscaping integration.
  • Approvals and NOC complexity, particularly inside gated communities with strict design guidelines.

Hidden Costs Homeowners Often Forget to Budget For

These are the line items that catch first-time pool owners off guard.

  • DEWA running costs, with pumps, heaters, and coolers typically adding AED 300–800+ per month depending on pool size and usage.
  • Ongoing water top-up, given significant evaporation rates in Dubai’s climate, especially in summer.
  • Annual maintenance contracts, generally AED 3,000–8,000+ per year depending on service frequency and pool size.
  • Safety compliance items, such as pool fencing, alarms, or covers.
  • Landscaping and decking beyond the pool itself, often quoted as a separate line item from the shell and equipment.



How Long Does a GRP Swimming Pool Last in Dubai’s Climate?

With correct installation and reasonable care, a GRP swimming pool shell is engineered to perform structurally for 25 to 30 years or more. Three factors determine actual lifespan on the ground in Dubai:

  1. Installation quality, particularly correct backfilling procedure and base preparation.
  2. Water chemistry management, since consistently poor pH balance or excessive chlorine can degrade any pool surface prematurely.
  3. Material and manufacturing quality, including glass fibre content, resin quality, and gelcoat thickness applied at the factory stage.

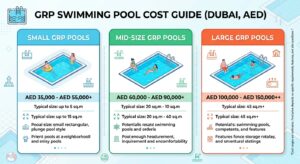

Infographic showing GRP swimming pool cost ranges in Dubai by size and type



Maintenance Tips to Maximize a GRP Swimming Pool’s Lifespan

Even though a GRP swimming pool demands far less upkeep than a concrete alternative, a small amount of consistent care goes a long way in Dubai’s demanding climate.

  • Balance water chemistry weekly, maintaining pH between 7.2–7.6 and monitoring chlorine or salt levels.
  • Run filtration during peak heat hours to help control algae growth risk.
  • Brush the gelcoat surface periodically, even though it is non-porous, to prevent surface film buildup around waterline scum lines.
  • Inspect equipment seasonally, since pumps, filters, and heating/cooling units work harder in Dubai’s summer.
  • Shock-treat after heavy use, particularly following pool parties or large gatherings.
  • Protect against sun and sand with a pool cover to reduce evaporation and chemical consumption.
  • Schedule an annual professional inspection of the gelcoat surface, plumbing connections, and surrounding soil and drainage.



Common Mistakes to Avoid With GRP Swimming Pool Projects in Dubai

Based on years of installation and repair work across the emirate, these are the recurring issues seen when projects go wrong.

  • Choosing a contractor without proper GRP fabrication experience. Ask specifically about their manufacturing process, gelcoat supplier, and shell thickness specifications.
  • Skipping soil investigation. Installing without understanding a plot’s soil composition and water table depth is one of the most common causes of post-installation problems.
  • Rushing the backfill-and-fill sequence. Cutting corners here risks shell distortion that surfaces months later as cracking or an uneven pool floor.
  • Skipping municipal or developer approvals to save time. This almost always costs more in the long run through fines, forced rework, or legal complications during a future property sale.
  • Under-specifying filtration and pump capacity. Undersized systems struggle to keep water clear and cost more in energy and chemicals over time.
  • Choosing the cheapest quotation without checking gelcoat quality and laminate thickness. A shell that is too thin to meet engineering specification may look identical to a properly built one until problems appear years later.
  • Ignoring pool cooling needs. Many first-time Dubai pool owners retrofit a cooling system after the fact at higher cost than including it at installation.

Pool technician performing maintenance on a GRP swimming pool in Dubai



GRP Swimming Pools for Rooftop, Podium, and Commercial Projects in Dubai

While villa installations are the most common application, GRP swimming pools have become increasingly important in Dubai’s broader construction landscape for a very specific engineering reason: weight.

  • Rooftop residential pools, increasingly popular in premium townhouse and low-rise developments, where a lightweight GRP shell fits structural load limits that would make a full concrete pool impossible.
  • Podium-level pools, common in mid-rise residential buildings above parking or retail podiums.
  • Hotel and resort pools, where GRP construction allows faster turnaround during renovation or new-build phases, minimizing disruption to guests.
  • Community and clubhouse pools, where fast installation reduces disruption to residents during construction.

If a project involves any of these scenarios, it is worth engaging a structural engineer alongside a GRP swimming pool contractor early in the design phase, before manufacturing begins.



GRP Swimming Pool Design Trends Across Dubai in 2025–2026

Working across multiple villa communities and commercial sites gives a useful vantage point on where preferences are heading.

  • Darker gelcoat finishes (deep blue, charcoal, and slate tones), which show less visible dust and sand accumulation than lighter tones.
  • Integrated sun ledges and tanning shelves, now a standard request rather than a luxury add-on.
  • Smart pool automation, with app-controlled lighting, temperature, and filtration scheduling.
  • Combined heating and cooling systems, specified at the design stage rather than retrofitted later.
  • Compact plunge pools for smaller plots and rooftop amenity space, often under 20 square metres.
  • Water-efficient design features, including pool covers and variable-speed pumps built into the initial specification.



Why Work With an Experienced GRP Manufacturer and Installer in Dubai

A GRP swimming pool is only as good as the hands that laminate it and the team that installs it. This is exactly why every project is approached as a full in-house capability rather than outsourcing critical stages:

  • In-house GRP laminators, mould fabricators, and gelcoat applicators, keeping quality control under one roof.
  • Dedicated GRP structural engineers and CAD design teams, engineering every shell to the specific loading and soil conditions of the site.
  • Experienced site supervisors specifically for swimming pool installations, overseeing excavation, crane placement, and backfill sequencing.
  • A track record across major Dubai developments, having delivered GRC, GRP, and related composite works for developers including Emaar, Damac, Sobha, Nakheel, and Shapoorji Pallonji, alongside dedicated pool projects such as our Desert Leisure Swimming Pools L.L.C. project.
  • ISO 9001:2015-certified quality management, ensuring every stage of manufacturing and installation follows a documented, auditable process.

When evaluating quotations, it is worth asking every contractor directly whether they manufacture the shell themselves or subcontract fabrication while only managing installation. Reviewing a provider’s full GRP manufacturing and installation services list is a useful way to confirm the scope of in-house capability before signing a contract.



Is a GRP Swimming Pool Right for Your Dubai Property? A Practical Decision Framework

To bring this together, here is a straightforward way to think about the decision.

A GRP swimming pool is likely the right choice for properties that:

  • Need the pool ready for use within weeks, not months.
  • Are budget-conscious about long-term chemical and maintenance costs.
  • Sit on a rooftop, podium, or weight-restricted installation site.
  • Prefer a smooth, comfortable, algae-resistant surface.
  • Are built on sandy or reactive soil common across many Dubai communities.

A concrete pool may still be worth considering for properties that:

  • Need a highly bespoke, irregular architectural shape no standard or semi-custom GRP mould can accommodate.
  • Involve a very large-scale commercial or infinity-edge feature pool requiring custom formwork.
  • Have a design that genuinely requires unlimited geometric flexibility.

For the vast majority of Dubai villa owners, apartment developments, and commercial projects, a GRP swimming pool delivers the best practical balance of speed, durability, comfort, and long-term value.

Rooftop GRP swimming pool installation overlooking the Dubai skyline



Final Thoughts

A swimming pool in Dubai is not just a lifestyle feature; it is a serious investment that needs to withstand one of the world’s most demanding climates for decades. Before making a final decision, keep these three takeaways in mind:

  • Installation quality and manufacturing quality determine long-term performance far more than the material choice alone.
  • A GRP swimming pool, when specified correctly, offers a genuinely superior combination of speed, durability, and long-term value compared to traditional construction methods for most Dubai properties.
  • The smartest first step is a proper site assessment from a contractor with real in-house GRP manufacturing capability, not just installation experience.

Reviewing our full GRP (Glass Reinforced Plastic) product range is a practical starting point for comparing shell options before requesting a formal site survey.



Frequently Asked Questions

What is the main difference between a GRP swimming pool and a concrete pool?

A GRP swimming pool is manufactured as a single, seamless composite shell in a factory and then installed on site, while a concrete pool is built layer by layer directly in the ground. This gives GRP pools faster installation, a smoother non-porous surface, and better resistance to cracking, while concrete offers unlimited custom shapes and suits very large or highly bespoke designs.

How long does it take to install a GRP swimming pool in Dubai?

Most GRP swimming pool installations in Dubai take between 1 and 3 weeks for the physical installation once the shell arrives on site, and 3 to 6 weeks in total from initial site survey to final handover, factoring in approvals, excavation, and equipment installation.

How much does a GRP swimming pool cost in Dubai?

A standard residential GRP swimming pool in Dubai typically starts from around AED 60,000 and can range up to AED 130,000 or more depending on size, depth, and features, while smaller plunge pools can start from approximately AED 50,000. Larger, custom, or commercial GRP pools can exceed AED 250,000 depending on scale and specification.

Is a GRP swimming pool more durable than a concrete pool in Dubai’s climate?

A properly installed GRP swimming pool resists corrosion, salt damage, and surface cracking better than concrete in many respects, since it has no exposed steel reinforcement and its flexible composite structure tolerates minor ground movement well. Both materials can last 25 years or more, but GRP typically requires significantly less resurfacing and repair work over that lifespan.

Do GRP swimming pools need less maintenance than concrete pools?

Yes, GRP swimming pools generally require less maintenance because their smooth, non-porous gelcoat surface resists algae growth far more effectively than porous concrete or grouted tile surfaces. This typically translates into lower chemical usage, less frequent brushing, and no need for periodic re-tiling or re-plastering.

Can a GRP swimming pool be installed on a rooftop or podium level in Dubai?

Yes, GRP swimming pools are one of the most practical options for rooftop and podium-level installations because the shell is significantly lighter than an equivalent concrete structure, making it easier to meet a building’s structural load limits. A structural engineer should always confirm load capacity before installation on any elevated surface.

What approvals are required for a GRP swimming pool in Dubai?

Most residential GRP swimming pool installations in Dubai require Dubai Municipality approval covering structural and plumbing plans, and properties inside master-planned communities also typically need a developer No Objection Certificate. Commercial or large-scale projects may additionally require Civil Defence approval depending on the site.

How long does a GRP swimming pool last before it needs to be resurfaced?

A well-installed GRP swimming pool shell is engineered to last structurally for 25 to 30 years or more, with the gelcoat surface typically remaining in strong cosmetic condition for 10 to 15-plus years before homeowners consider a re-gelcoat refresh. This is generally far less invasive and less costly than re-tiling or re-plastering a concrete pool of a similar size.
