GRG ceiling installation in Dubai is a structured five-phase process – design consultation and site assessment, factory panel casting, on-site fixing, surface finishing, and final inspection under live lighting. The full process takes 2 to 20 weeks depending on project scale. Glass Reinforced Gypsum (GRG) is the preferred ceiling material for Dubai’s luxury residential, hospitality, and commercial interiors because it holds a Class 0 fire rating under BS 476, withstands the UAE’s extreme heat and humidity, reproduces any architectural ceiling geometry with sub-millimetre accuracy, and arrives on site pre-finished and ready to install.
Walk into any five-star hotel on Sheikh Zayed Road. Step inside the formal majlis of a Palm Jumeirah villa. Stand in the lobby of a premium commercial tower in DIFC or Business Bay. The first thing your eye is drawn to is almost never the floor or the walls. It is the ceiling.
Dubai’s interior design and fit-out market is one of the most competitive construction environments in the world. The UAE interior design market was valued at over USD 12 billion in 2024 and is projected to reach USD 18.62 billion by 2032, growing at more than 5% per year. Within that market, the pressure on contractors is constant – deliver finishes that photograph beautifully, comply with strict Dubai Civil Defence fire codes, and hold up for decades in a climate that regularly exceeds 45°C.
GRG ceiling installation is not a product you order and fit over a weekend. It is a craft. It demands engineering at the design stage, precision manufacturing in a controlled factory environment, skilled tradespeople on site, and a finishing process that requires patience and technical experience at every step.
This guide walks through every phase of that complete process – from the moment a client first describes what they want, to the moment the last inspection is signed off and the lights come on for the very first time.
What Is a GRG Ceiling? Definition, Composition, and Why It Matters in Dubai
Before exploring the GRG ceiling installation process, it is worth being precise about what GRG ceiling material actually is – because the term is frequently used loosely in Dubai’s construction market, sometimes interchangeably with materials it has nothing to do with.

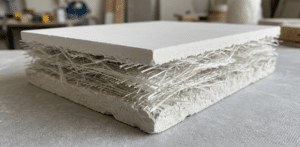

GRG stands for Glass Reinforced Gypsum. It is a composite building material made by combining two primary components:
- High-strength alpha-hemihydrate gypsum plaster – a higher-purity, denser form of gypsum than what is used in standard plasterboard.
- Alkali-resistant glass fiber reinforcement – chopped strands or woven matting embedded throughout the gypsum matrix to provide tensile strength the gypsum alone cannot achieve.
These two materials are cast together in precision moulds to produce:
- Flat and profiled ceiling panels of any dimension.
- Coffered ceiling modules with deep or shallow relief.
- Full plaster domes and barrel vaults.
- Custom cornices, dadoes, and architectural profiles.
- Decorative ceiling medallions and feature rings.
What GRG Is NOT:
It is important to understand what GRG is not, because specifying the wrong material leads to compliance failures, surface quality problems, and in some cases structural issues:
- It is not standard gypsum board – which is a flat, site-applied panel with limited design capability and a lower fire classification.
- It is not Plaster of Paris (POP) – which is site-mixed, less dimensionally stable, and cannot be pre-finished.
- It is not GRC (Glass Reinforced Concrete) – which uses a cement matrix rather than gypsum and is designed primarily for exterior facades and structural cladding, not interior painted ceiling surfaces.
The glass fiber reinforcement in GRG – typically 2–5% of total panel weight – is what allows a GRG panel spanning 2 metres to flex slightly without fracturing during installation, to be transported across a city without shattering, and to remain structurally intact through decades of normal building movement. For a full technical breakdown of GRG as a material, including its full composition, fire rating specifications, acoustic properties, and available surface finishes, the product page covers every specification in detail.
GRG vs. Other Ceiling Materials – The Comparison Every Project Specifier Needs
| Property | GRG | Standard Gypsum Board | POP (Plaster of Paris) | GRC | Precast Concrete |
| Weight per m² | 10–18 kg | 8–12 kg | 15–25 kg | 25–40 kg | 80–150 kg |
| Fire Rating | Class 0 | Class 1 | Unrated | Class 0 | Class 0 |
| Design Flexibility | Very High | Low | Medium | High | Low |
| Surface Finish Quality | Excellent | Good | Good | Rough | Rough |
| Moisture Resistance | High | Low | Low | Very High | Very High |
| Typical Lifespan | 25–40 years | 10–15 years | 10–20 years | 30–50 years | 50+ years |
| Relative Cost | Medium–High | Low | Low–Medium | High | Very High |
| Best For | Luxury interior ceilings | Standard offices and apartments | Decorative detailing | Exterior facades | Structural elements |
GRG is the only material in this comparison that combines a luxury-grade surface finish, Class 0 fire rating, complex design capability, and a weight light enough for standard suspended ceiling systems. That specific combination is precisely why it dominates Dubai’s premium interior ceiling sector.
5 Reasons Dubai’s Construction Industry Relies on GRG Ceiling Installation
Dubai Civil Defence (DCD) Fire Compliance
The UAE Fire and Life Safety Code of Practice requires ceiling materials in commercial, hospitality, and high-rise residential buildings to meet Class 0 fire performance under BS 476. In practical terms, the material must satisfy all three of the following criteria:
- Not support ignition under direct fire conditions.
- Do not contribute to surface flame spread across its face.
- Don’t produce toxic combustion gases when exposed to heat.
GRG meets Class 0 natively and without any added chemical treatment. Gypsum contains approximately 20% chemically bound water by weight, which is released as steam during fire exposure. That steam acts as a natural thermal barrier, significantly delaying the heating of the structure behind the ceiling. You can review the current fire rating and compliance certifications held for GRG materials on the certification page.
UAE Climate Resilience
Dubai’s climate is genuinely hostile to many conventional building materials. Consider the conditions GRG must perform in:
- Summer ambient temperatures: Regularly 45–48°C outdoors, with ceiling void temperatures often exceeding 55°C.
- Winter coastal humidity: Relative humidity regularly reaching 70–90% during fog periods.
- Daily temperature cycling: Between air-conditioned interiors and warmer void spaces above suspended ceilings.
GRG has no organic component whatsoever. It does not warp in heat, does not swell in humidity, does not rot, does not harbour mould, and does not off-gas volatile organic compounds as it ages. GRG maintains its dimensional stability and surface integrity for 25 to 40 years in properly maintained interior environments – a lifespan that standard gypsum board, POP, and timber-based ceiling systems simply cannot match in the UAE climate.
Lightweight for Dubai’s High-Rise Suspension Systems
Dubai’s high-rise structural slabs are engineered to carry calculated ceiling loads per square metre. GRG delivers exceptional strength-to-weight performance:
- A coffered GRG panel spanning 1.2 metres weighs just 15–20 kilograms with its suspension armatures.
- The same feature in precast concrete weighs 80 kilograms or more.
- The precast version would require structural engineering modifications to the suspension system – modifications that are rarely feasible within an interior fit-out project scope or budget.
Precision for Dubai’s Luxury Interior Standards
Dubai’s luxury residential and hospitality clients regularly specify ceiling designs of a complexity that would be considered exceptional in most other global markets. The following are standard requests across the emirate’s premium interior sector:
- Persian-inspired geometric lattice patterns cast to full ceiling scale.
- Multi-tier coffered ceilings with deeply recessed wells and integrated LED cove lighting.
- Full plaster domes with hand-modelled relief detail and invisible suspension.
- Curved bulkheads and continuous cornices with seamless joint finish.
- Custom medallions and feature rings integrated into flat ceiling planes.
GRG reproduces every one of these design forms to sub-millimetre accuracy from a precision mould – no other interior ceiling material achieves this level of geometric consistency at scale.
Factory Pre-Finishing Compresses On-Site Timelines
In Dubai’s deadline-driven construction environment, the GRG factory model delivers a concrete schedule advantage:
- The most labour-intensive phase – casting, curing, and surface quality control – happens off-site in parallel with other on-site construction activities.
- By the time GRG panels arrive at site, they are dimensionally accurate, surface-finished, and ready to fix.
- What arrives on site is an assembly operation, not a fabrication operation.
- That distinction regularly saves 2–4 weeks on medium-to-large Dubai projects – and weeks matter when hotel opening dates and residential handover milestones are tied directly to revenue streams.
GRG Ceiling Design Consultation and Site Assessment in Dubai
The most expensive mistakes in GRG ceiling installation in Dubai happen before a single panel is manufactured. They happen in the consultation and assessment phase – or more accurately, they happen when this phase is rushed, skipped entirely, or handled by someone who does not know what they are looking for.
A professional GRG ceiling contractor in Dubai will never:
- Quote a project over the phone without visiting the site.
- Produce a price per square metre based on a floor plan or elevation drawing alone.
- Begin manufacturing without shop drawings that carry written approval from all required parties.
Every one of those shortcuts looks like a cost or time saving at the outset. Every one of them becomes an expensive problem during installation.
The Initial GRG Ceiling Consultation: What a Professional Actually Evaluates
A professional site visit for a GRG ceiling project in Dubai is a technical feasibility review, not a sales presentation. Three things must be determined before any design work begins:
- Whether the project is structurally and geometrically feasible as described by the client or designer.
- What the project will actually cost to deliver at the required quality standard.
- What programme, coordination, and compliance risks need to be identified and managed before contracts are signed.
What the Consultant Assesses at the First Visit:
- Design intent vs. structural reality – The gap between what a client envisions and what the building’s structural conditions will allow. A design requiring 800mm of clear height below the structural slab soffit may not be achievable in a standard Dubai apartment.
- Budget alignment – Honest assessment of what the client’s budget can deliver, covering design complexity, mould costs, panel count, finish standard, and MEP integration scope.
- Project sequencing – GRG ceiling installation must come after structural completion and full MEP rough-in, and before wall finishes, floor finishes, joinery, and furniture. Establishing this sequence with the main contractor, MEP subcontractor, and interior designer at the first visit prevents the most common cause of quality failures on Dubai ceiling projects.
- Contractor coordination requirements – Identifying who else will be working in the same zone and what formal coordination protocols are needed to protect the GRG installation.
GRG Ceiling Site Assessment: Reading the Space Before Designing for It
The site assessment is the technical due diligence phase of any GRG ceiling installation project in Dubai. Every design and manufacturing decision made downstream depends on what this assessment reveals. A thorough site assessment covers the following five areas:
Ceiling Height and Clear Height Analysis
The space between the structural slab soffit and the required finished ceiling level must accommodate all of the following:

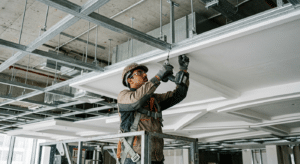

- The full depth of the galvanised suspension system framing.
- The GRG panel thickness and any integrated back-frame armatures.
- Integrated lighting back-boxes and recessed fixtures behind the panel face.
- MEP services – HVAC ductwork, sprinkler mains, electrical conduit – running through the ceiling void.
Minimum clear heights required for each GRG ceiling type:
| GRG Ceiling Type | Minimum Clear Height Below Slab |
| Flat GRG panel ceiling | 150–200mm |
| Coffered or tiered ceiling up to 300mm deep | 400–600mm |
| Full dome ceiling feature | 600mm to 1,500mm+ |
| Barrel vaults and custom curved features | Variable – calculated from geometry |
Discovering a clear height shortfall after manufacturing has started is an extremely costly lesson.
Structural Slab Survey
Dubai’s high-rise buildings use post-tensioned concrete slab construction extensively. These slabs contain high-strength steel cables tensioned after the concrete is poured. Drilling a chemical anchor into a post-tension slab at the wrong location can sever one of those cables – with consequences ranging from costly structural repair to, in worst-case scenarios, partial slab failure.
A professional GRG ceiling contractor takes the following steps before drilling any anchor:
- Uses Ferroscan, ground-penetrating radar, or equivalent cable-mapping technology to locate and map all cable positions.
- Positions every suspension anchor in a confirmed clear zone between cables.
- Obtains written clearance from the structural engineer or consultant before drilling begins.
- Documents all anchor positions on the as-built shop drawings at project completion.
Beyond post-tension cables, the structural survey also identifies:
- Beam positions that affect suspension system layout.
- Slab thickness variations that change the anchor specification.
- Existing MEP penetrations that restrict available anchor zones.
- Any evidence of previous water ingress, cracking, or slab deflection.
MEP Coordination Review
A GRG ceiling installation is a permanent architectural installation. Once panels are fixed, jointed, skimmed, primed, and painted, the void above is largely inaccessible. Every MEP element must be in its confirmed final position before the ceiling goes up.
The MEP coordination review maps and confirms the following positions:
- HVAC supply and return air diffusers – verified against the mechanical engineer’s duct layout drawing.
- Fire sprinkler heads – confirmed against the DCD-approved firefighting drawing.
- Smoke detectors and emergency lighting – per the DCD-approved fire alarm drawing.
- Recessed lighting – confirmed against the lighting designer’s reflected ceiling plan.
- Speaker, AV, and data equipment positions.
- Access panel locations for equipment requiring periodic maintenance.
Any conflict between confirmed MEP positions and the proposed GRG panel layout is resolved on paper at this stage. On site, the same correction costs time, money, and physical damage to completed work.
Dubai Regulatory Compliance Review
The site assessment also confirms what compliance submissions are required before installation begins, covering:
- Dubai Civil Defence (DCD) – BS 476 Class 0 fire rating certificates for GRG materials.
- Dubai Municipality – Material approval submissions for government buildings, educational facilities, and healthcare projects.
- DEWA – All electrical work within the GRG ceiling must be executed by a DEWA-approved contractor.
- Trakhees – For free zone projects in JAFZA, Dubai Media City, Dubai Internet City, or Dubai Design District, a separate Trakhees approval process applies.
Existing Condition Documentation
Before any work begins, the existing condition of the space is fully photographed and recorded:
- Pre-existing cracks in the slab or surrounding walls.
- Water staining or evidence of previous ingress from above.
- Remnants of any previous ceiling installation.
- Any evidence of building movement or settlement.
This documentation protects both the contractor and the client if questions about the source of any future issue arise.
GRG Ceiling Design Development: From Client Concept to Buildable Geometry
The design development phase takes three inputs – the client’s vision, the site’s structural constraints, and the confirmed MEP layout – and produces a ceiling design that can be manufactured, delivered, and installed without surprises.
The Four Stages of GRG Ceiling Design Development:
Concept and Reference Review
At this stage, the contractor works through:
- The client’s reference imagery, mood board, or architect’s concept drawings.
- Identification of specific design elements – dome radius, coffer depth, cornice profile, lighting integration zone widths.
- Translation of aesthetic intent into specific, buildable design parameters.
- Initial design feasibility against structural constraints already identified in the site assessment.
3D Modelling and Client Visualisation
For any project involving more than basic flat ceiling panels, design moves into three-dimensional modelling. Software tools used in professional GRG ceiling design in Dubai:
- AutoCAD – 2D construction drawings, section details, plan layouts, and set-out information.
- Rhino or SketchUp – 3D geometric modelling for curved surfaces and complex profiles.
- 3ds Max or Lumion – Photorealistic rendering with accurate lighting simulation for client approval.
The rendering stage is a quality control step. A coffered ceiling that reads as proportionate in a 2D plan may reveal awkward proportions in 3D when the lighting simulation shows how shadows fall into the coffer wells. These issues are free to correct in a 3D model. They are very expensive to discover after manufacturing.
Panel Layout and Joint Optimisation
Dividing the overall ceiling design into manufacturable and installable panel modules requires four criteria to be satisfied simultaneously:
- Structurally logical – Joints must fall directly over suspension frame members that can carry the panel loads.
- Aesthetically invisible – Joint lines must align with the ceiling’s geometry so they disappear into the design after finishing.
- Physically manageable – Each panel must be a size and weight that two or three people can safely lift and fix.
- Sequentially achievable – The installation order must be physically possible, with each panel accessible without being blocked by a previously installed one.
Satisfying all four simultaneously across a complex ceiling geometry is where years of completed GRG ceiling installation projects in Dubai make a measurable difference.
MEP Integration into Panel Design
Once the panel layout is finalised, all confirmed MEP positions are overlaid onto each individual panel’s manufacturing drawing. Cutout positions for lighting fixtures, HVAC diffusers, sprinkler heads, and smoke detectors are marked and made in the factory – not on site with an angle grinder, which produces inaccurate openings and damages the surrounding panel surface.

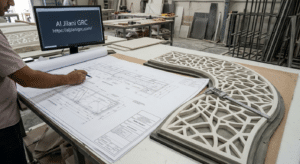

Shop Drawing Production and Formal Approval
Shop drawings are the documents from which the actual GRG ceiling installation is built. Design drawings communicate aesthetic intent. Shop drawings communicate the technical instructions required for execution.
The Shop Drawing Approval Chain in Dubai:
On a typical Dubai GRG ceiling project, formal approval passes through the following parties before manufacturing begins:
- Client or client’s authorised representative.
- Interior designer or architect of record.
- Main contractor.
- Consultant engineer.
- Dubai Municipality or Trakhees, where required by the project category.
Manufacturing does not begin until written approval is received from all required parties – without exception. The cost of manufacturing panels against drawings that later require revision is entirely preventable.
Red Flag for Clients: Any GRG ceiling contractor who offers to begin manufacturing before shop drawings are formally approved is either operating without adequate quality controls or misrepresenting their process. Neither is acceptable on a premium ceiling project.
GRG Ceiling Panel Manufacturing: The Factory Process That Determines Quality
This phase happens entirely off-site in a controlled factory environment. It is the phase where the quality of the finished ceiling is most fundamentally determined. Everything that happens on site – the precision of the installation, the quality of the joints, the flatness of the surface – is bounded by the quality of the panels that arrive from the factory.
This is exactly why “where are the panels manufactured?” matters just as much as “who will install them?”
Mould Making: The Foundation of Every Bespoke GRG Ceiling Design
Every GRG ceiling feature that does not exist as a standard off-the-shelf profile requires a custom mould. The mould is produced before any GRG is cast, and its quality directly determines the quality of every single panel produced from it.
GRG Mould Types Used in Dubai Projects:
| Ceiling Feature | Mould Type | Material |
| Flat panels and standard profiles | CNC-machined flat moulds | Melamine-faced MDF board |
| Arched and gently curved features | Formed curved moulds | Marine-grade plywood, fiberglass-faced |
| Full domes, vaults, custom profiles | Master moulds | Polyurethane foam with fiberglass shell |
| Repeating intricate decorative elements | Multi-cast production moulds | Silicone or polyurethane rubber |
Key Facts About Mould Quality:
- A scratch across a mould face appears on every panel cast from it, on the visible painted face.
- For a project with 200 identical coffered panels, a flaw in the mould means 200 flawed panels.
- Moulds for premium projects are inspected before each cast, repaired at the first sign of surface damage, and withdrawn from use if they cannot produce a face coat that meets the finish specification.
- Mould precision is not a cost to minimise – it is an investment in every single panel the mould produces.
The GRG Panel Casting Process: Layer by Layer
The casting of a GRG ceiling panel follows a precise sequence of six layers. Each must be applied at the correct stage of the previous layer’s cure. Getting this sequence right is the core technical skill of GRG manufacturing.
Mould Preparation
- The mould surface is coated evenly with a release agent – a petroleum-based wax or specialist chemical release formulation.
- Applied correctly and evenly, it allows clean demolding without surface damage.
- Applied unevenly, it causes partial bonding that tears the panel face during demolding.
Face Coat Application (The Visible Surface)
- Pure alpha-gypsum slurry is brushed or sprayed onto the mould to a depth of 3–4mm.
- This layer becomes the visible, painted face of the finished ceiling panel.
- For a flawless result, it must be: completely free of air bubbles, evenly distributed with no thin spots or runs, and applied quickly enough to complete before initial set reduces workability.
- In Dubai’s summer months, factory ambient temperatures can reach 38–42°C. At these temperatures, alpha gypsum sets in as little as 8–10 minutes from mixing – experienced casting teams adjust mix ratios and work in smaller batches.

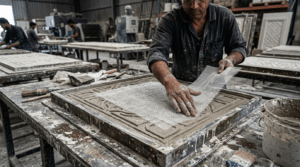

First Glass Fiber Reinforcement
- Alkali-resistant glass fiber rovings are chopped into 30–50mm lengths and simultaneously deposited into the still-wet face coat.
- Glass fiber content is controlled at 2–5% of total panel weight – too little reduces tensile strength; too much causes glass strands to telegraph through the painted surface.
Build-Up Coats
- Alternating layers of gypsum slurry and glass fiber are applied to build the panel to its specified total thickness.
- Standard GRG ceiling panels: 10–20mm thick.
- Spanning or structural elements: up to 40mm thick.
- Each layer is applied while the previous one is still green – ensuring a continuous chemical and mechanical bond through the full panel depth, not a laminar structure that can delaminate.
Structural Armature Integration (For Large or Complex Panels)
- Galvanised steel flat bars, angle sections, or purpose-welded frames are cast into the final wet layers for panels that:
- Span more than approximately 1.2 metres.
- Carry cantilever sections.
- Are curved in a way that makes them inherently flexible.
- These armatures become permanently embedded in the GRG matrix.
- They are what allows large-format panels to be handled, transported, and fixed without cracking.
Demolding and Curing
- Panels are demolded 30–60 minutes after the final layer – early enough to prepare the mould for the next cast, late enough to hold their form cleanly.
- After demolding, panels are stored flat or in custom racking systems.
- Never stacked face-to-face without protective padding between them.
- Never leaned at steep angles that could cause warping during cure.
- Full structural strength develops after 7 days, with residual curing continuing for up to 28 days in thicker sections.
Factory Quality Control for GRG Ceiling Panels
Every GRG ceiling panel produced for a Dubai project undergoes a formal five-point quality control inspection before leaving the factory:
- Dimensional accuracy check – Length, width, and thickness measured against shop drawing specifications. Accepted tolerance: ±2mm on plan dimensions, ±1mm on thickness. Curved panels are checked against a template made from the shop drawing.
- Surface inspection under raking light – The panel face is examined using a low-angle raking light that reveals surface voids, fibre telegraphing, mould marks, and any imperfection that direct overhead lighting would conceal.
- Weight verification – Panel weight checked against the calculated design weight. Overweight panels indicate excess slurry and may exceed suspension load specifications. Underweight panels may have insufficient glass fiber content.
- Glass fiber distribution check – Sample panels from each production run are broken in a controlled manner to verify uniform glass fiber distribution through the full panel depth. Non-uniform distribution indicates a mixing or application fault that must be corrected before the run continues.
- Panel numbering and delivery documentation – Every panel is labelled with its unique shop drawing reference, installation location code, and orientation marking. Delivery documentation matches panel numbers to the installation sequence so the site team receives panels in the correct order.
UAE-Local Manufacturing vs. Imported GRG Panels: Why It Matters for Dubai Projects
| Factor | UAE-Manufactured GRG | Imported GRG Panels |
| Lead time | 1–3 weeks | 6–14 weeks including shipping |
| Customs and duty risk | None | Variable – clearance delays possible |
| Transport damage risk | Low | Moderate to High for profiled elements |
| Mid-project design adjustments | Achievable within days | Very difficult and costly to re-manufacture |
| Manufacturer site visits | Practical and routine | Not practical from overseas |
| Defect accountability | Direct – one organisation responsible | Fragmented between supplier and installer |
| Suitability for bespoke projects | High | Low to Medium |
For bespoke GRG ceiling installation in Dubai, UAE-based manufacturing delivers schedule flexibility, direct quality accountability, and the ability to respond rapidly to site changes – advantages that imported panel systems simply cannot match in a market where project timelines are commercial commitments.
On-Site GRG Ceiling Installation in Dubai: The Full Technical Breakdown
The manufacturing phase produces components. The installation phase turns those components into a finished ceiling. Manufacturing quality provides the foundation for a successful result, but on-site execution is where every decision – good or bad – becomes visible and permanent.
There are six sequential stages to a professional on-site GRG ceiling installation. Each must be completed and verified before the next begins. Rushing any single stage to save a day almost always costs a week later in rework.
Site Preparation: Confirming Readiness Before a Single Panel Moves
The following checklist is non-negotiable. If any single item is not confirmed and documented, installation does not begin.
- MEP rough-in is 100% complete and inspected. Every mechanical, electrical, and plumbing service running through the ceiling void must be in its final position, fixed, and signed off by the relevant engineer. Services moved after GRG installation require cutting through finished panels – every time, without exception.
- Structural anchors are approved and pull-tested. All suspension anchor positions have been marked, Ferroscanned on post-tension slabs, drilled, chemical anchor-filled, and torque-tested to the required pull-out load. The structural engineer has confirmed all positions and specifications are correct.
- Access equipment is certified and in place. Dubai premium ceiling heights regularly reach 4 to 8 metres. Scissor lifts, aluminium tower scaffolding, or certified MEWPs must be erected and inspected before installation begins. Improvised working platforms at 6-metre height produce imprecise results, not safe ones.
- Adjacent completed surfaces are fully protected. Marble floors, stone cladding, glazed facades – anything already finished that could be damaged by gypsum dust, plaster splashes, or panel movement – must be covered and sealed before any installation activity begins.
- Adequate temporary lighting is active in the work zone. Joints that look acceptable under 100-lux construction lighting look clearly unacceptable under 1,000-lux LED downlights. Temporary lighting in the work zone should approximate the level and angle of the intended finished lighting – minimum adequate illumination to see the work clearly.
Layout and Marking: The Precision That Prevents Rework
Before any suspension component is fixed, the entire ceiling layout from the shop drawing is transferred to the site using precision surveying methods.
Setting the Datum Line
- The finished ceiling height datum is established using a laser level – not a tape measure from the slab soffit.
- The slab carries construction tolerances of ±10–15mm across a span, plus possible high spots and sag zones.
- Measuring from the slab produces a ceiling that follows every one of those imperfections faithfully.
- Measuring from a laser datum produces a ceiling that is genuinely flat and level.
Transferring the Panel Grid to the Slab Soffit
The following are marked and verified before drilling begins:
- All suspension drop rod positions, transferred from shop drawing coordinates.
- Main channel lines at the correct spacing.
- Cross channel spacing corresponding to the panel module grid.
- On complex designs involving domes, multiple tiers, or curved elements – a total station surveying instrument transfers key reference points to millimetre accuracy.
Pre-Drilling Verification
Before a single drill touches the slab, every marked anchor position is cross-checked against three criteria:
- Confirmed against the shop drawing coordinates.
- Ferroscanned for rebar and post-tension cable clearance on PT slabs.
- Checked for MEP service conflicts above the proposed anchor position.
A 10mm error in marking a suspension anchor position becomes a 30–50mm misalignment at the centre of a long panel span. There is no correcting it without removing installed panels and remarking the entire area.

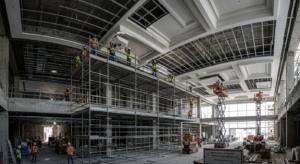

GRG Suspension System Installation: The Hidden Backbone
The suspension system holds the entire GRG ceiling in place for 25 to 40 years. It is completely concealed once panels are fixed. Its concealment makes it tempting to cut corners on specification and installation quality. A professional GRG ceiling contractor in Dubai does not.
Suspension System Components – Full Specification for Dubai Projects:
| Component | Specification | Function |
| Slab anchors | M10 chemical anchors or expansion bolts, load-rated and pull-tested | Transfer ceiling dead load into the RC structure |
| Drop rods | M8 or M10 galvanised threaded rod | Connect slab anchors to the main channel grid |
| Main channels | 50×50mm or 75×50mm galvanised G.I. sections | Primary horizontal load-bearing members |
| Cross channels | Galvanised 47×17mm furring channels | Secondary grid to receive panel fixing screws |
| Wall angle | Galvanised 25×25mm L-angle | Perimeter support and edge alignment |
| Levelling clips | Adjustable M8 rod clips | Fine height adjustment of main channels |
| Bracing wires | Galvanised 12-gauge wire, X-braced at intervals | Lateral stability for deep suspension systems |
Why Galvanised Steel Is Non-Negotiable for GRG Ceiling Installation in Dubai
Dubai’s coastal environment exposes concealed ceiling voids to a combination of three corrosion accelerants:
- High ambient humidity – particularly during winter fog periods and high-pressure humidity events.
- Temperature cycling – between air-conditioned interiors and the warmer, less-controlled void space above the ceiling.
- Concrete alkalinity – migrating moisture from the structural slab above.
Standard mild steel in this environment shows significant corrosion within 3–5 years. Galvanised steel components resist corrosion for 25 years or more – matching the intended design life of the GRG ceiling itself. The cost difference between galvanised and mild steel components is marginal on any project budget. The consequences of under-specifying are not marginal at all.
The Framing and Levelling Sequence – Step by Step:
- Install perimeter wall angle at the laser datum height – level checked in both directions.
- Install all slab anchors at their marked and cleared positions.
- Hang galvanised drop rods from slab anchors.
- Install main channels suspended from drop rods at the correct height.
- Level all main channels using a laser level – this is the single most consequential step for achieving a genuinely flat finished ceiling.
- Install cross channels across main channels at the panel module spacing.
- Conduct a final laser level check across the entire framed area before any panel is fixed.
Fixing GRG Ceiling Panels: The Craft of Assembly
The Panel Installation Sequence – Why Order Matters
The sequence in which GRG ceiling panels go up is not arbitrary. It follows a defined logic that accumulates precision from boundary to centre:
- Perimeter panels first – Establish the fixed boundary condition that all internal panels reference. Install and verify full alignment before moving inward.
- Architectural feature elements second – Domes, central medallions, curved bulkheads, and signature ceiling features are positioned and fixed before the surrounding field panels constrain their adjustment.
- Field panels last – The large volume of standard flat or coffered field panels fills the ceiling once both the perimeter boundary and architectural features are established and verified.
Fastener Selection – Right Screw for the Right Environment
- Galvanised steel screws for standard dry interior applications – offices, residential reception rooms, hotel corridors.
- Stainless steel screws for areas with elevated ambient humidity – pool-adjacent spaces, spa treatment areas, and below-grade basement zones.
- Screws are driven flush with the panel back only – never countersunk deeply into the panel face, which creates stress concentrations that cause surface cracking at fixing points under load.
Handling Large and Curved Panels Safely
Large flat panels at 2.4 × 1.2 metres and 15mm thickness weigh approximately 30–40 kilograms with armatures. Safe handling at 6-metre ceiling height on scissor lifts requires:
- Two people on the lift controlling the panel at height.
- One or two people on the ground managing the lower end during the lift phase.
- A clear, agreed lifting sequence for every panel discussed before it moves.
- Temporary prop jacks and timber wedges holding each panel until fixings fully engage.
For curved panels: Any curved panel forced against its design curvature during installation will crack. The first sign is a hairline fracture in the face coat that widens as the panel is secured. The correct response is to stop immediately, re-examine the frame geometry, and correct the frame. Never force the panel.
GRG Joint Treatment: Where the Ceiling Becomes Seamless
Here is the honest truth about GRG ceiling installation: If panels are manufactured correctly, the panel face is already close to perfect when it arrives on site. The joint between panels is where the ceiling either comes together as a seamless, monolithic whole or reveals itself as an assembly of separate pieces under lighting.
Joint treatment is the most skill-dependent, most time-sensitive, and most consequential phase of the entire on-site installation. The quality of the finished joint is almost entirely a function of the tradesperson’s skill and the time allowed for each stage to cure completely before the next begins.
The Five-Step Joint Treatment Process:
Joint Preparation
- Joint faces of both panels are cleaned of dust, gypsum powder, and any residual release agent.
- The joint gap is measured – 1–3mm is ideal. Gaps wider than 5mm require a backing rod inserted before filling to prevent the compound from sinking as it cures.
Non-Shrink Bonding Adhesive
- A non-shrink, high-strength GRG-compatible adhesive compound is applied into the joint gap.
- Non-shrink formulation is non-negotiable – standard compounds shrink as they dry, pulling the fill surface inward and creating a visible depression that corresponds exactly to the joint line and reappears after painting, even through multiple skim coats.
Alkali-Resistant Fiberglass Scrim Tape
- Fiberglass mesh scrim tape, typically 50–75mm wide, is pressed into the wet adhesive across the full length of every joint.
- Two distinct functions:
- During installation: Holds compound in position while it cures, preventing sagging.
- Long-term: Bridges the joint and distributes stress from building movement and thermal cycling across a 50–75mm band on either side of the joint line – rather than concentrating it at the joint itself.
- This is why a correctly treated GRG joint does not crack under normal building movement, while an incorrectly treated one will crack within months of the first movement event.
Feathering and Smoothing
- Additional fill compound is applied over the embedded tape and feathered outward on both sides over a distance of 150–200mm.
- Feathering creates a gradual, imperceptible transition from the filled joint surface to the surrounding GRG panel face.
- Results by feathering technique:
- Feathered correctly → joint is invisible after painting.
- Too steep an edge → a ridge appears under raking light.
- Too shallow a taper → a raised band catches directional light.
Cure and Raking Light Inspection
- After full cure – minimum 24 hours in Dubai’s winter conditions, 12–18 hours in summer – every joint is inspected under a raking light.
- A portable LED light held at an oblique angle reveals: ridges, depressions, holidays in the fill, raised tape edges, and areas where feathering was insufficient.
- Every deficiency is corrected before finishing work begins. This internal raking light inspection is the contractor’s own quality standard – not the client’s walkthrough.
MEP Integration During GRG Ceiling Installation
Integrated ceiling elements require ongoing coordination with MEP trades throughout the installation phase, not only before it begins.
Recessed Lighting Back-Boxes:
- Must be positioned flush with the finished panel face to within 1mm.
- A back-box 3mm recessed: the lighting bezel leaves a visible gap around its perimeter.
- A back-box 2mm proud: the bezel cannot sit flat against the ceiling surface.
- Position is verified by the GRG installer before joint treatment begins – corrections are free at this stage and very expensive after finishing.
HVAC Diffuser Frames:
- Set into pre-cut panel openings and checked for both level and flush position.
- The perimeter of each frame is finished with a thin bead of compatible compound, sanded smooth, and treated as a standard finish joint before skim coating begins.
Fire Sprinkler and Smoke Detector Penetrations:
- Made using factory-cut panel openings of confirmed dimensions.
- Where DCD requires fire-rated collars around sprinkler penetrations, these are installed by the mechanical contractor after the GRG panel is fixed and the sprinkler is at its final confirmed height.
GRG Ceiling Finishing in Dubai: The Process That Determines What the Eye Sees
Finishing a GRG ceiling is a completely different discipline from painting a wall. The combination of a high-reflectance surface, directional LED lighting positioned to graze the ceiling plane, and a client who has paid premium for the space means that any surface imperfection will be seen. The finishing phase is where accumulated quality from all previous phases either shows through cleanly or fails in plain sight.
First Fix: Sanding, Filling, and Surface Preparation
The Systematic Sanding Sequence:
| Pass | Grit | Primary Purpose |
| Initial pass | 80–100 grit | Remove high spots, rough joint feathering edges, and casting surface irregularities |
| Second pass | 120–150 grit | Smooth joint transitions and the general panel face |
| Finish pass | 180–220 grit | Prepare the entire surface for skim coat or direct primer |
What Each Sanding Pass Covers:
- Each pass covers the full ceiling surface – not just the joint zones.
- The panel face itself may carry very minor variations from casting – slight surface waviness or marginally coarser texture – that become visible after painting if not addressed now.
- After each sanding pass, pin holes and surface voids are filled, allowed to cure, re-sanded, and re-inspected under raking light.
- On luxury hospitality projects with cove lighting raking directly across the ceiling surface, this fill-sand-inspect cycle may run three or four times before the surface meets the finish specification.
Dust Management on Active Dubai Construction Sites:
GRG sanding produces fine white gypsum dust that travels aggressively through an uncontrolled space. Professional installers manage this through:
- Vacuum-assisted sanding tools that capture the majority of dust at the source.
- Polythene dust barriers sealed at the work zone perimeter.
- Active coordination with other trades working concurrently in adjacent areas.
- Coordination with the project’s overall dust management protocol agreed with the main contractor.
Skim Coat Application: The Standard That Defines Luxury GRG Ceiling Finishing
A skim coat is a thin, full-surface application of finish plaster or proprietary skim compound across the entire ceiling surface – not only at the joint zones. It is a levelling and surface unification operation.
What a Skim Coat Achieves:
After sanding, the GRG ceiling surface has two zones with subtly different textures:
- The original cast panel face – dense, smooth alpha gypsum texture.
- The joint filler areas – marginally different texture from the fill compound.
Under painted finish, these two zones can read differently. They absorb paint at different rates and appear as subtle tonal variations under raking light – a soft stripe across the ceiling corresponding to every joint line. A 1–2mm skim coat applied uniformly across the entire surface creates a single, consistent texture everywhere. The ceiling reads as one unbroken plane.
When Skim Coating Is Non-Negotiable on Dubai GRG Ceiling Projects:
- Hotel lobbies, ballrooms, and all public hospitality areas.
- Luxury residential formal reception rooms and master bedroom ceiling features.
- Any space where LED cove lighting, strip lighting, or wall-washers run near or across the ceiling plane.
- Premium commercial boardrooms and client-facing office environments.
- Photography, video, and broadcast studio environments.
Level 5 Finish Standard:
Level 5 is the highest plaster and drywall finishing classification. It requires a full skim coat over the entire primed surface – producing a surface completely featureless under 90-degree grazing light. It is the expected baseline standard for Dubai’s five-star hospitality clients and ultra-luxury residential ceiling installations.
Primer Application: The Most Important Step That Most Contractors Skip
Gypsum is highly absorbent and alkaline. Paint applied directly to unprimed GRG soaks in unevenly – more in porous areas, less in denser zones – producing a patchy, inconsistent sheen called “flashing” that becomes dramatically more visible under LED lighting.
Why Flashing Cannot Be Corrected With More Paint:
- The porosity variation beneath the surface amplifies with every additional coat.
- Each coat of paint over an unprimed surface makes the problem worse, not better.
- The only correction is: sand back, prime correctly, and repaint – more time, more material cost, and more disruption than proper priming would have required.
Correct Primer Specification for GRG Ceiling Installation in Dubai:
- Alkali-resistant primer formulated specifically for gypsum substrates.
- Applied by roller in a single uniform coat with brush cuts at all perimeter edges and MEP penetrations.
- Minimum 4–6 hours cure time at Dubai’s ambient temperatures before any subsequent application.
Post-Primer Raking Light Inspection:
After primer cures, the ceiling is inspected one final time under raking light. The primer coat unifies the colour of GRG face and joint compound into a single off-white tone, making any remaining surface imperfections far more visible than they were on the bare sanded surface. Every imperfection identified at this stage is addressed – filled, sanded, spot-primed – before finish paint begins. This is the last practical opportunity to correct surface deficiencies without the significant cost of stripping paint from an installed ceiling.
Paint Application for GRG Ceilings in Dubai
Paint Properties That Matter – and Why:
| Property | Recommendation | Reason |
| Sheen level | Matte or dead-flat | Scatters light diffusely – hides minor surface variations |
| Formulation | Water-based acrylic | Compatible with gypsum; no off-gassing; re-coatable without issues |
| Opacity / hide | High-hide formulation | Achieves full opacity in two coats |
| Application method | Roller for flat areas, brush for profiles | Consistent film thickness without over-atomisation |
| Colour in critical lighting zones | White or near-white | Minimises shadow depth in surface variations |
Why High-Sheen Paint Fails on GRG Ceilings:
Eggshell, satin, or semi-gloss paint on a GRG ceiling reflects light directionally – toward the viewer from the direction of the light source. Any surface variation – even a 0.5mm wave in the skim coat – creates a visible highlight-and-shadow contrast that a matte finish would not produce. Luxury hotel ceilings across Dubai are consistently painted matte for precisely this reason.
Number of Coats Required:
- Two finish coats over primer – standard for most interior applications.
- Three finish coats for: deep or saturated colours, surfaces with higher porosity variation despite priming, or ceiling areas carrying high-output directional lighting.
For GRG ceiling installation projects that also include adjacent wall painting work, coordinating both under the same finish specification – the same product line, the same sheen level, the same colour temperature reference – is the most reliable way to achieve a cohesive, unified interior result. Details on professional painting contracting services in Dubai cover how this coordination is managed across complex fit-out projects.
Lighting Integration and the Final Verification
Recessed lights, cove LED strips, spotlights, and all ceiling-integrated luminaires are installed after paint is complete and fully cured. This is the most important verification stage of the entire GRG ceiling installation project.
What Live Lighting Reveals:
Live lighting under the specified luminaires reveals every remaining imperfection that every previous inspection missed:
- Joint ridges or depressions invisible under diffuse construction lighting.
- Paint sheen inconsistencies across the ceiling plane.
- Panel edge height differences of 1mm or less casting visible shadow lines.
- HVAC or lighting bezels marginally out of flush with the finished panel face.
- Skim coat waves undetectable under ambient light.
The Professional Response to Post-Lighting Imperfections:
The correct response to any deficiency identified at this stage is to address it – sand, fill, re-prime, and repaint. The response that marks out an unprofessional contractor is to try to explain it away as an inherent characteristic of the material. It is not an inherent characteristic of the material. It is a deficiency in the installation or finishing process.
Lighting Scene Commissioning Test:
The final commissioning test checks ceiling appearance under all specified scenes:
- Full bright – maximum output from all fixtures simultaneously.
- Ambient evening scene – reduced intensity for relaxed occupation.
- Accent-only – feature lighting illuminating architectural elements.
- Emergency lighting – confirming illumination coverage per the DCD-approved drawing.
Any dark zones, uneven illumination, or lighting hot spots that create harsh brightness variation on the ceiling surface are addressed either by redirecting fixtures or adding supplementary lighting before the client is invited to inspect.
Final Inspection and Project Handover: The Professional Close
Most articles about GRG ceiling installation end at “paint and install lights.” The handover process is where a professional contractor is distinguished from a transactional one – and where the client’s long-term satisfaction with the installation is genuinely secured.
Internal Pre-Handover Punch List
Before any client is invited to inspect, the following internal quality checks are completed systematically:
- Raking light inspection – Every panel face and joint line inspected from floor level and from lift height using a portable LED raking light.
- Tap test – Every panel and joint area tapped with a rubber mallet. A hollow resonant sound indicates delamination, poor adhesive bonding, or a void in the joint fill. Every hollow area is investigated and corrected.
- Laser level verification – A laser level checks the entire ceiling plane. Deviations beyond tolerance are investigated and corrected.
- Live lighting test – All specified luminaire types and all lighting scenes switched on and evaluated.
- MEP penetration check – Every diffuser, light fitting, speaker grille, and access panel verified for flush position and clean finished perimeter.
- Paint finish review – Checked for holidays (missed areas), lap marks from roller changes, drips at perimeter edges, and sheen inconsistencies across the full ceiling plane.
Only when every item on this internal list is resolved does the client receive an invitation to inspect.
Client Walkthrough and Professional Snag Management
How the Client Walkthrough Is Conducted:
The client and their interior designer or project manager walk through the completed space under live lighting. The process follows a structured sequence:
- Walk the perimeter of the space first, checking the ceiling at normal viewing distance from the floor.
- Walk through the centre of the space, checking the ceiling plane for flatness and lighting uniformity.
- Close-inspection pass at all architectural feature areas – dome soffits, coffered ceiling details, cornice profiles, and cove lighting zones.
Every client observation is processed as follows:
- Documented on a formal snag sheet with a location reference and a photograph.
- Categorised as one of three types:
- Genuine installation defect – does not meet the agreed finish specification. The contractor’s responsibility to correct.
- Material characteristic – inherent to GRG and within the agreed specification. For example, slight casting texture visible close-up on a ceiling specified at Level 4 rather than Level 5.
- Design characteristic – shown in the approved shop drawings and inherent to the agreed panel layout.
- Assigned a correction timeline agreed and documented at the walkthrough.
Handover Documentation: What a Professional GRG Ceiling Contractor Provides
| Document | What It Contains | Why It Matters |
| As-built shop drawings | Actual installation layout with deviations from original drawings noted | Future MEP modifications or ceiling repairs can be planned without guesswork |
| GRG material certificates | BS 476 Class 0 fire rating, glass fiber spec, gypsum grade | Required for DCD compliance records and future building audits |
| Paint product data sheets | Product name, sheen level, colour reference, batch numbers | Enables precisely matched touch-up paint at any future date |
| Maintenance guidelines | Cleaning methods, crack monitoring, touch-up procedure | Enables building management to maintain the ceiling correctly |
| Written warranty document | Scope, duration, exclusions, and claims process | Commercial protection if defects emerge within the warranty period |
Warranty and Post-Handover Support
What a GRG Ceiling Warranty Should Cover:
- Structural failure of panels or the suspension system resulting from installation workmanship.
- Joint cracking directly attributable to installation workmanship – not building structure movement.
- Surface delamination within the defined warranty period.
What a Warranty Typically Excludes:
- Cracking caused by building settlement or structural movement beyond normal tolerances.
- Damage from water ingress originating above the ceiling from plumbing or roof leaks.
- Cosmetic wear from cleaning with abrasive or solvent-based products.
- Damage caused by third-party contractors working in the space after handover.
GRG Ceiling Installation Dubai – Critical Local Factors That Shape Every Project
Everything covered in the previous sections describes the GRG ceiling installation process as it should be executed on any project, anywhere. This section covers what is specific to the UAE – the regulatory environment, the climate challenges, and the market conditions that experienced GRG contractors in Dubai navigate on every single project.
Dubai Regulatory and Compliance Requirements for GRG Ceiling Work
Dubai Civil Defence (DCD) Fire Safety
GRG ceiling materials used in commercial, hospitality, or high-rise residential buildings in Dubai, compliance requires all of the following:
- A valid test certificate demonstrating Class 0 performance under BS 476, Parts 6 and 7.
- The certificate must be issued by a recognised third-party testing laboratory.
- It must apply specifically to the GRG formulation and thickness being used on the project.
- It must be current – not a historical certificate issued for a different product or a different manufacturer.
DCD inspectors can and do request material certificates during site inspections. A GRG ceiling without supporting fire rating documentation can result in a hold order on the building’s occupancy certificate – a delay that costs far more than the certification would have cost at the project’s outset. The certification page lists the current accreditations, ISO certification, and approvals held for materials used on UAE projects.
Dubai Municipality Material Approvals
For the following project categories, Dubai Municipality requires formal material approval submissions before installation begins:
- Government buildings and public authority offices.
- Educational facilities at all levels.
- Healthcare facilities and clinics.
- Certain categories of publicly accessible commercial buildings.
Initiating this submission at the beginning of the design phase – not during manufacturing – avoids it becoming a critical-path programme delay.
DEWA Requirements
All electrical installations within a GRG ceiling – including lighting back-boxes, conduit systems, and fixture connections – must be:
- Designed by a DEWA-approved electrical engineer.
- Executed by a DEWA-approved electrical contractor.
- Coordinated directly with the GRG ceiling contractor throughout the installation phase.
Trakhees Regulations for Free Zone Projects
Projects in the following Dubai free zones are regulated by Trakhees, not Dubai Municipality:
- Jebel Ali Free Zone (JAFZA).
- Dubai Media City.
- Dubai Internet City.
- Dubai Design District (d3).
- Dubai Healthcare City and other TECOM-managed zones.
Trakhees operates its own material approval and inspection process, running independently of the DM process. Contractors unfamiliar with Trakhees procedures regularly cause delays on free zone projects. Confirm free zone project experience before signing any GRG ceiling contract for a free zone location.
Climate-Specific Installation Challenges for GRG Ceiling Work in Dubai
Dubai Summer (May–September): The Heat Challenge
The specific technical problems summer creates for GRG ceiling installation and finishing:
- Accelerated gypsum setting – At 38°C, alpha gypsum working time falls to 8–10 minutes from mixing (vs. 15–20 minutes at 25°C). Experienced installers use retarder additives and work in smaller sections.
- Surface skinning before through-cure – Joint compound and skim coat skin over on their surface while the interior is still soft. When the interior later dries and contracts, the already-rigid surface skin cracks. Solution: multiple thin applications rather than single thick fills.
- Factory casting management – Experienced casting teams adjust mix water ratios, work in smaller batches, and may add retarder to extend workable life during peak summer production.
Dubai Winter (November–February): The Humidity Challenge
High coastal humidity creates different but equally important challenges:
- Extended cure time – Joint compounds and skim coats cure significantly more slowly in high ambient humidity, extending the time required between application passes.
- Surface bloom – A white, powdery crystalline deposit on fresh gypsum work caused by moisture migrating to the surface and carrying dissolved gypsum salts. Surface bloom causes paint adhesion failure if not removed before priming. Solution: adequate ventilation and, in critical spaces, dehumidification equipment.
Occupied Buildings – Air Conditioning Challenges
Installing a GRG ceiling in an occupied or partially occupied building – a hotel in phased refurbishment, an occupied office floor below – creates specific finishing challenges:
- Cold, dry conditioned air causes the same surface-skinning-before-through-cure problem as summer heat, but through moisture removal rather than temperature.
- Dust from sanding is distributed more aggressively by conditioned airflow, requiring more stringent dust containment.
- Solution for both: thin, multiple-pass applications and more frequent inspection of cure stage before proceeding.
Realistic GRG Ceiling Installation Timelines for Dubai Projects
| Project Type | Design and Drawings | Manufacturing | Installation | Finishing | Total Duration |
| Apartment feature ceiling (under 50m²) | 3–5 days | 5–7 days | 3–5 days | 3–5 days | 2–4 weeks |
| Luxury villa full ceiling (200–400m²) | 2–3 weeks | 2–3 weeks | 2–3 weeks | 1–2 weeks | 8–14 weeks |
| Commercial office fit-out | 1–2 weeks | 1–2 weeks | 2–3 weeks | 1–2 weeks | 6–10 weeks |
| Hotel lobby or ballroom | 3–5 weeks | 3–4 weeks | 4–6 weeks | 2–3 weeks | 12–20 weeks |
| Full hotel floor plate | 4–6 weeks | 4–8 weeks | 8–12 weeks | 3–4 weeks | 20–32 weeks |
The Five Most Common Causes of Timeline Overrun on Dubai GRG Ceiling Projects (in order of frequency):
- Shop drawing approval delays caused by continued design changes after submission.
- MEP service changes after GRG manufacturing has already begun.
- Main contractor access restrictions limiting productive working time on site.
- Panel damage during site handling requiring re-manufacture of specific panels.
- Inadequate scaffolding or access equipment provided too late in the project programme.
GRG Ceiling Installation Cost in Dubai – What Actually Drives the Price
There is no credible single per-square-metre price for GRG ceiling installation in Dubai that applies accurately across the range of projects the emirate produces. Cost variation between a simple flat panel ceiling in a standard-height commercial space and a multi-tier coffered ceiling with integrated dome features in a luxury villa can be tenfold on a per-square-metre basis.
Factors That Drive GRG Ceiling Cost Upward:
- Higher design complexity – more unique mould types and more panel variants.
- Small production runs – a unique dome amortised across a single unit carries high mould cost per square metre.
- High ceiling heights – scaffolding, working time, and installation complexity all increase proportionally.
- Level 5 versus Level 4 finish standard requirement.
- Compressed project schedule – accelerated manufacturing and on-site work carry a premium.
- Complex MEP integration with many penetrations, custom access panels, and active coordination.
Factors That Allow GRG Ceiling Cost to Be Managed:
- Repetitive panel design – the same coffer module across 150 panels amortises mould investment efficiently.
- Accessible ceiling heights – 3 to 4 metre heights are significantly faster and less costly to work at than 6 to 8 metre heights.
- Well-coordinated MEP confirmed before shop drawings are produced – eliminating the most common source of variations and rework.
- Realistic project schedule – time pressure has a direct cost premium; an achievable programme allows work to be done correctly the first time.
Important Consumer Note: Any GRG ceiling contractor who provides a firm per-square-metre price without visiting your site and reviewing your design is either quoting for something different from what you are expecting, or will raise substantial variation claims during the project. Always insist on a site-assessed quotation based on your specific design and MEP layout.
How to Choose the Right GRG Ceiling Contractor in Dubai
Dubai’s GRG ceiling market includes contractors operating at very different levels of technical capability, quality commitment, and professional practice. The seven questions below will tell you which category any contractor falls into – before you sign a contract and before manufacturing begins.
The 7 Questions That Reveal a GRG Ceiling Contractor’s Real Capability
“Do you manufacture GRG in-house, or do you outsource the casting?”
- In-house manufacturing: The same organisation that installs the ceiling controls every panel’s quality. When a defect is found, one party is accountable for correcting it.
- Outsourced manufacturing: Introduces an accountability gap – the installer blames the manufacturer, the manufacturer blames the installer’s handling, and the client waits in the middle.
“Do you produce shop drawings internally?”
- A contractor who cannot produce their own shop drawings is a fitting contractor who depends on others for the technical planning.
- Shop drawings require integrated knowledge of suspension engineering, MEP coordination, panel sequencing, and joint logic – not drafting skills, but applied construction knowledge.
“What is your specific MEP coordination process?”
- Correct answer: a formal coordination meeting before design is finalised, a drawing exchange overlaying confirmed MEP positions onto the GRG shop drawing, written sign-off before manufacturing begins, and site verification before installation starts.
- “We coordinate with whoever we need to” is not a process – it is an intention with no structure.
“Can you provide current DCD fire rating certificates for the specific GRG materials you will use?”
- Correct answer: yes, immediately, here they are.
- “We can get those” or “all GRG is fire rated” are not acceptable answers.
- Not all GRG products carry current, third-party verified Class 0 certification for the specific formulation and thickness being specified.
“Who will supervise the installation daily, and are they dedicated to this project?”
- The quality of a GRG ceiling installation is directly correlated with the consistent daily presence of an experienced supervisor.
- Ask for the supervisor’s name. Ask how many other active projects they will manage simultaneously.
- A supervisor managing five projects simultaneously is not a dedicated supervisor.
“Can you provide a written warranty document now?”
A written warranty must specify:
- What is covered – structural failure, joint cracking from workmanship, surface delamination.
- What is excluded – building movement, third-party damage, water ingress from above.
- Duration – and whether it differs for structural vs. cosmetic claims.
- The claims process – whom to contact, required documentation, committed response time.
“Can you provide contact details for three comparable completed GRG projects in Dubai that I can visit or call?”
- Portfolio photographs are selected and curated. Real, inspectable, contactable references are not.
- Visit those installations. Look at them under live lighting.
- This is the single most reliable quality indicator available before committing to any GRG ceiling contractor.
What Experienced GRG Ceiling Contractors in Dubai Deliver
The following capabilities are what the seven questions above are designed to verify. Contractors who hold all of them consistently deliver GRG ceiling installations that meet Dubai’s highest quality standards:
- In-house GRG manufacturing – Direct quality control at every stage of production, with no accountability gap between manufacturer and installer.
- Complete shop drawing production – By an in-house technical team using AutoCAD and 3D modelling, covering every panel, anchor, and joint.
- Structured MEP coordination – Applied from the site assessment stage on every project, with formal drawing exchanges and written sign-offs.
- Current DCD fire rating certificates – BS 476 Class 0 fire rating certificates for all materials used in commercial and hospitality projects.
- Dedicated site supervisors – Assigned individually to projects and present throughout the installation phase, not visiting periodically between other commitments.
- Written warranty documentation – Provided at every project handover, with defined scope, duration, and claims process.
- Full handover documentation – As-built drawings, material certificates, paint data sheets, and maintenance guidelines on every completed project.
- Proven project portfolio – Completed GRG, GRC, and GRP ceiling projects across luxury residential, commercial fit-out, and hospitality sectors across Dubai and the wider UAE.
For a look at completed projects across these sectors, the project portfolio provides a reference library of work completed across different project scales, design complexities, and specification requirements. The full range of GRG, GRC, and GRP manufacturing and installation services – from design assistance through to maintenance – is covered in detail on the services page.
To understand the manufacturing background and the team behind the projects, the introduction page covers the company’s foundation, its manufacturing facility, and its decade-plus track record across GCC construction and fit-out markets. The partners page=”font-weight: 400;”> lists the main contractors and developers – including Emaar, Damac, Shapoorji Pallonji, Sobha, Nakheel, and Khansaheb – with whom completed projects have been delivered.
Frequently Asked Questions About GRG Ceiling Installation in Dubai
What is a GRG ceiling?
A GRG ceiling is an interior ceiling system manufactured from Glass Reinforced Gypsum – alpha-hemihydrate gypsum plaster reinforced with alkali-resistant glass fiber. It is factory-cast in precision moulds to produce custom panels, domes, coffered modules, cornices, and architectural profiles. GRG ceilings are widely used across Dubai’s luxury residential, hospitality, and commercial interiors for their Class 0 fire rating, superior surface quality, and ability to reproduce any ceiling geometry with precision.
<h3>What is the difference between GRG and GRC ceiling?
GRG (Glass Reinforced Gypsum)le=”font-weight: 400;”> uses a gypsum matrix and is designed for interior ceiling and wall applications – lightweight, high surface finish quality, DCD fire compliant. GRC (Glass Reinforced Concrete) uses a cement matrix and is designed for exterior facades and structural cladding – heavier, highly weather-resistant, but with a rougher surface unsuitable for interior painted finishes. The two materials are often confused in Dubai’s market but serve completely different purposes. The GRC product page and the GRG material page cover each material’s specifications separately.
Is GRG ceiling fire rated for use in Dubai?
Yes. GRG meets Class 0 fire performance under BS 476, Parts 6 and 7 – the classification required by Dubai Civil Defence for ceiling materials in commercial, hospitality, and high-rise residential buildi
ngs. GRG is non-combustible, does not contribute to flame spread, and does not produce toxic gases. Valid, current third-party test certificates must be available for the specific product and thickness used on any DCD-regulated project.
How much does GRG ceiling installation cost in Dubai?
GRG ceiling installation cost in Dubai cannot be accurately stated per square metre without a site assessment and design review. Key cost drivers include design complexity, number of unique mould types, ceiling height, finish standard required, MEP integration scope, and project timeline. Any per-square-metre price offered without a site visit is an indication only, not a project cost. Get in touch for a site-assessed quotation based on your specific project.
How long does GRG ceiling installation take in Dubai?
Timeline depends on project scale:
- Small apartment feature ceiling (under 50m²): 2–4 weeks total.
- Luxury villa full ceiling (200–400m²): 8–14 weeks total.
- Hotel lobby or ballroom: 12–20 weeks total.
The design and shop drawing approval phase is the most variable element – typically 1–3 weeks on well-organised projects, up to 6 weeks on projects where the brief continues to change after submission.
What is the difference between GRG ceiling and gypsum board ceiling?
GRG is factory-cast in precision moulds, capable of producing any three-dimensional geometry, with superior surface hardness and a Class 0 fire rating. Gypsum board is a site-applied flat board system – faster to install for standard flat ceilings, lower in cost, but limited to flat or gently curved forms and carrying a lower fire classification. For standard suspended ceiling areas, gypsum board ceiling systems are a practical solution. For feature ceiling areas requiring complex geometry and a premium finish, GRG is the correct specification.
Can GRG ceiling be installed outdoors in Dubai?
Standard GRG is not suitable for fully exposed outdoor environments. Gypsum degrades with sustained direct water exposure. For covered semi-outdoor areas – shaded terraces, air-conditioned atriums with limited external exposure – GRG can be used with moisture-resistant primer and paint systems. For fully exterior environments in the UAE, GRC (Glass Reinforced Concrete) or GRP (Glass Reinforced Plastic) are the correct material specifications.
Can GRG ceiling integrate with smart lighting systems?
Yes. GRG ceilings are fully compatible with all major smart lighting and home automation platforms – Lutron, DALI, KNX, Crestron, and similar systems. All back-boxes, conduit runs, and cable routing pathways are incorporated into the GRG panel design during the design phase, resulting in a ceiling with no exposed conduit and no visible electrical infrastructure after completion.
What maintenance does a GRG ceiling require?
GRG ceilings require minimal routine maintenance:
- Clean with a soft dry cloth for dust, or a lightly damp cloth for marks.
- Avoid abrasive cleaners, solvent-based products, and high-pressure washing.
- Minor joint cracks after the warranty period can be repaired by a qualified GRG contractor.
- For touch-up painting, always use the same product, sheen level, and batch reference recorded in the handover documentation.
Who installs GRG ceilings in Dubai?
GRG ceilings in Dubai are installed by specialist GRG ceiling contractors who combine in-house manufacturing capability with on-site installation expertise. The most capable contractors handle the full process – design, shop drawings, mould making, casting, on-site installation, joint treatment, finishing, and handover documentation – as a single end-to-end service. For a full overview of the GRG manufacturing and installation capability offered across UAE projects, the GRG services page covers the complete scope from design through to maintenance.
Ready to Start Your GRG Ceiling Installation Project in Dubai?
A GRG ceiling is one of the longest-lasting and most architecturally impactful elements of any interior space. Done with a proper, structured process – from the first site assessment through factory manufacturing, on-site installation, finishing, and documented handover – it defines the character of a room and holds its quality for decades.
Done incorrectly – rushed through the shop drawing phase, manufactured to loose tolerances, installed without MEP coordination, finished without skim coating, and handed over without documentation – it becomes one of the most expensive and most visible problems a building owner faces.
For any GRG ceiling installation project in Dubai – luxury residential, hotel or resort, commercial fit-out, or any premium interior environment – a professional site assessment and design consultation is the right place to begin.
