A container home in Sharjah is possible, but it is never a “buy a box and park it” project. It is a permitted building that happens to start life as steel shipping containers. Treat it that way from day one and the process is manageable. Treat it like furniture and you risk fines, a stop-work notice or forced removal.
You have probably seen the glossy photos. A sleek black 40-foot box, a timber deck, a desert sunset. Then you searched, and found conflicting answers: “it is illegal,” “it is easy,” “it costs AED 50,000,” “it costs AED 500,000.” This guide cuts through that noise.
It is written for homeowners, farm and ezba owners, landlords, small developers and Dubai-based buyers who are looking at Sharjah because land and building costs can be lower than in Dubai, and the Sharjah industrial belt (including Al Sajja) already hosts the fabricators, steel workshops and finishing contractors a container build needs.
Quick Answer: Container Home in Sharjah at a Glance
- Is it legal? Yes in principle, when the structure is approved as a building: stamped drawings from a licensed consultant, a municipality permit, utility approval and civil defence sign-off. There is no “no paperwork” route.
- Where can you build? Only on land whose ownership and zoning allow residential or accommodation use. Not every plot, and not freely in the desert.
- How much does it cost? As a planning range, roughly AED 90,000 to AED 350,000 for a properly insulated, air-conditioned 40-foot unit, depending on finish, plus land, foundations, approvals and utility connections. See the cost tables below.
- How long does it take? Plan for 4 to 9 months door to door: design, approvals, fabrication and site works.
- Biggest technical risk? Heat and humidity. Steel boxes without correct insulation and vapour control become ovens by May.
- Biggest legal risk? Starting fabrication before the permit is in your hand.
Important: This article is general guidance, not legal or engineering advice. Rules, fees and zoning change and differ by plot. Always confirm with Sharjah Municipality and your appointed consultant before you commit money.
What You Will Learn in This Guide
- What a container home really is, and why Sharjah is attracting interest
- The regulations and approvals that apply, and who issues them
- A step-by-step permit roadmap
- Realistic costs, with line-by-line budget tables
- How to find, vet and compare container home suppliers
- How to beat the heat: insulation, cladding, ceilings and floors
- Design ideas, build sequence, pros, cons and the mistakes to avoid
- An image plan with ALT text, and 8 direct-answer FAQs
Who This Guide Is For
- Homeowners and landowners exploring a compact, fast-build home or guest unit
- Farm and weekend-retreat owners around Sharjah and the northern emirates
- Dubai residents comparing Sharjah with Dubai’s stricter and costlier process
- Small investors and developers considering rental units, studios or hospitality pods
- Business owners who want a site office, cafe or showroom built from containers
Why Trust This Guide?
This article is built on the way approvals and builds actually flow in the UAE: the authority chain (municipality, utility provider, civil defence), the engineering realities of steel in 45 degree heat, and the finishing trades that decide whether a container feels like a home or a warehouse. Where a number is an estimate, it is labelled as one. Where a rule is not published as a clear Sharjah-specific container regulation, we say so rather than guess.
What Is a Container Home, and Why Is Sharjah Attracting Interest?
A container home is a dwelling built from one or more ISO shipping containers that are cut, reinforced, insulated, fitted out and anchored on an engineered foundation. The steel shell is only the starting point. What turns it into a home is everything added to it: structure, thermal envelope, services and finishes.
The Container Sizes You Will Actually Meet

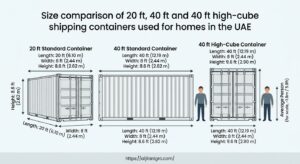

Most UAE suppliers work with a handful of standard formats. Dimensions below are nominal ISO sizes; interior space is smaller once insulation and linings go in.
| Container type | Approx. external size | Approx. floor area | Typical use |
|---|---|---|---|
| 20 ft standard | 6.06 m x 2.44 m x 2.59 m | about 14 m2 (150 sq ft) | Studio, majlis, site office, guest pod |
| 40 ft standard | 12.19 m x 2.44 m x 2.59 m | about 28 m2 (300 sq ft) | One-bedroom unit, cafe, clinic |
| 40 ft high cube | 12.19 m x 2.44 m x 2.90 m | about 28 m2 (300 sq ft) | Best choice for homes, 30 cm extra ceiling height for insulation and ducting |
| Combined 2 x 40 ft | about 6 m x 12 m footprint | about 56 m2 (600 sq ft) | Two-bedroom home, family unit |
New, One-Trip or Used Containers?
- New or “one-trip” containers: Made in Asia, shipped once with cargo, then sold. Cleaner, straighter, fewer dents. Recommended for housing.
- Used (multi-trip) containers: Cheaper, but may carry rust, floor treatment chemicals, dents and unknown cargo history. Needs inspection and sandblasting.
- Purpose-built modular units: Fabricated in a workshop from new steel to container dimensions. Often easier to certify because the structure is documented.
Expert tip: Ask for the container’s CSC plate and manufacturing date. If a seller cannot show it, treat the unit as unverified.
Why Container Homes Are Getting Attention in Sharjah
Sharjah has its own character. It is more conservative than Dubai, rich in heritage and culture, and has a strong industrial base. Several factors make container projects attractive here:
- Lower build cost potential. Shell fabrication is quick, and you avoid some masonry, shuttering and curing time.
- Speed. Much of the work happens in a workshop while foundations are prepared on site.
- Industrial ecosystem. Steel fabricators, MEP contractors, AC suppliers and finishing specialists cluster in areas such as Al Sajja, Industrial Areas and Al Qasimia.
- Flexible land uses. Farms, retreats, camps and small commercial plots can suit modular units, subject to approval.
- Relocation. A well-built unit can be disassembled and moved, which suits leased land and phased projects.
- Proximity to Dubai. Dubai buyers can reach most Sharjah sites in 25 to 45 minutes, depending on traffic.
Sharjah vs Dubai: What Dubai Readers Should Know
Many readers searching from Dubai ask whether they should build in Dubai or cross the border. The honest answer: the technical build is the same, but the approval path, land rules and costs differ.
| Factor | Sharjah | Dubai |
|---|---|---|
| Permit authority | Sharjah City Municipality, with Sharjah Urban Planning Council oversight | Dubai Municipality and Dubai Development Authority, depending on zone |
| Land ownership for foreigners | Generally limited to designated areas set by the Sharjah Executive Council (Law No. 2 of 2022); usufruct has historically been used | Freehold zones are widely available |
| Container-specific guidance | Not published as a dedicated residential container code; assessed as a prefabricated or steel building | Not a dedicated residential container code either; documentation is typically extensive |
| Cost of land | Often lower | Often higher |
| Typical approach | Consultant-led, case-by-case | Consultant-led, case-by-case with green building rules |
Source note: the authority and ownership points above draw on Dubizzle’s Sharjah building guides and Afridi & Angell’s summary of Sharjah Law No. 2 of 2022. Verify the current position with the authorities.
Common Myths About Container Homes in the UAE
- Myth: “They are always cheaper than concrete.” Reality: once you add insulation, AC, cladding, foundations and approvals, savings shrink. They are cheaper mainly in speed and flexibility.
- Myth: “Anyone can place one on any land.” Reality: ownership, zoning and approval decide everything.
- Myth: “Steel boxes are too hot for the UAE.” Reality: poorly insulated ones are. Properly engineered envelopes perform well.
- Myth: “They are temporary only.” Reality: they can be permanent if designed, approved and certified as a building.
If you want to see how architectural finishing elements are made and installed in Sharjah, browse Al Jilani GRC’s services and completed projects before you brief your designer.
Container Home in Sharjah Regulations: What Is Allowed and Who Approves It
There is no single, public “Sharjah container home law.” In practice, a container home is assessed as a prefabricated steel building. That means it follows the same permit logic as any other structure: a registered consultant, a municipality permit, utility approval, safety inspections and a completion certificate.
This is the part most blogs get wrong. They either promise a loophole or declare containers banned. Neither is accurate. The reality is approval by documentation, case by case.
Who Regulates a Container Home in Sharjah?
| Authority | What it controls | Why it matters to you |
|---|---|---|
| Sharjah City Municipality | Building permits, inspections and completion certificates through its e-services portal | Your main approval. Applications are submitted by an accredited consultant office |
| Sharjah Urban Planning Council (SUPC) | Urban design, master planning and plot development | Decides what your plot may be used for and how it may be developed |
| SEWA (Sharjah Electricity, Water and Gas Authority) | Power, water and gas connections and no-objection certificates near its networks | No connection means no legal supply |
| Sharjah Civil Defence | Fire and life safety approvals | Fire-rated materials, exits, alarms and extinguishing |
| Sharjah Executive Council | Designates areas and conditions for foreign ownership | Determines whether a non-national can hold land rights where you want to build |
| EPAA and heritage bodies | Coastal, protected and heritage-zone clearances | Only if your plot falls in those zones |
Sources: Dubizzle: building permit in Sharjah, Dubizzle: building project requirements, UAE Free Zone Finder: Sharjah permit guide 2026. The last is a commercial advisory site that does not cite official sources for its fees, so treat fee figures as indicative.
1. Land Ownership: Can You Even Build There?
Before design, confirm that you hold the right to build. This is a legal question, not a construction one.
- UAE and GCC nationals can generally own land in Sharjah.
- Foreign nationals can generally own freehold only in areas and projects designated by the Sharjah Executive Council under Sharjah Law No. 2 of 2022.
- Usufruct rights (a long-term right to use land owned by someone else, historically up to 100 years in specified areas) have been the traditional route for non-nationals.
- Leased land may allow a container structure only if the landlord and the authorities approve it in writing.
Practical rule: do not order a single container until your title deed, usufruct contract or written landlord consent is in hand.
2. Zoning and Plot Use
Every plot has an approved use. A container home must match it.
- Residential plots (villa zones): Strict rules on plot coverage, setbacks, height and appearance. Container homes are most likely to face aesthetic and design review here.
- Agricultural and farm plots: Often more flexible for guest units, but limits on built-up area and use still apply.
- Industrial and workshop plots: Suited to offices and staff accommodation, not usually to family homes.
- Commercial plots: Suited to cafes, kiosks, showrooms and clinics.
- Desert and unplanned land: Not a free-for-all. Land outside planned zones still needs rights, permission and access.
Check these before you start:
- The permitted use on your title deed or plot plan
- Maximum built-up area and number of floors
- Setbacks from boundaries, roads and neighbours
- Required parking and access
- Any master-developer rules if the plot sits inside a community
3. Structural and Engineering Requirements
Once you cut openings in a container wall, you remove the strength that made the box rigid. Authorities and consultants expect that to be engineered.
- Stamped drawings from a registered engineering consultant: architectural, structural and MEP
- Structural calculations for cut openings, stacked units and cantilevers
- Foundation design based on a soil report (strip, pad or raft, with leveling pedestals)
- Wind and anchorage design so the unit cannot move or tilt
- Certified welding and corrosion protection for all modifications
- Material guarantees handed to the owner. Dubizzle notes that original supplier guarantees must be handed over
Commercial guidance from Muscat Cargo makes the same general point for the UAE: converted containers are treated like buildings, with plans drawn by an architect or engineer and approved by the local municipality. It is a commercial source rather than an official regulation, so confirm the details with Sharjah Municipality.
4. Fire and Life Safety
This is where cheap builds fail inspection.
- Use fire-rated or non-combustible insulation where required. Avoid uncertified foam in occupied spaces.
- Provide two means of escape where the layout demands it.
- Install smoke detectors, alarms and extinguishers as specified by the consultant.
- Choose fire-rated linings around kitchens, electrical panels and plant.
- Keep clear separation from neighbouring structures.
Ask your consultant which edition of the UAE Fire and Life Safety Code of Practice applies to your project type, and request written confirmation of the fire strategy before fabrication.
5. Utilities: Power, Water, Sewage
- Electricity and water: Apply through SEWA via your consultant. A temporary construction supply is usually needed during the build.
- Drainage: Confirm whether your plot connects to a sewer network or needs an approved septic or holding tank, with licensed tanker removal.
- Air conditioning: Size the system on a proper heat-load calculation, not a rule of thumb.
- Gas: If you use LPG or network gas, only licensed installers may connect it.

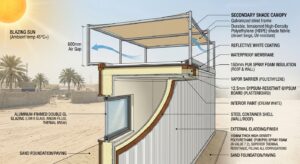

6. Insulation and Energy Performance
Sharjah’s guidance places responsibility on the consultant to supervise insulation work. For a container, that is not a detail. Insulation is the building. We cover the technical side in the heat section below.
Temporary vs Permanent Container Structures
| Question | Temporary | Permanent |
|---|---|---|
| Typical use | Site office, event unit, short lease | Home, guest house, rental unit |
| Foundation | Pads or sleepers | Engineered foundation |
| Permit | Still required in most cases | Full building permit and completion certificate |
| Utilities | Often temporary connections | Permanent SEWA connections |
| Risk | Removal order at lease end | Highest approval scrutiny, highest resale value |
Penalties and Risks of Building Without Approval
- Fines. One commercial source reports violation penalties in the AED 5,000 to AED 20,000 range, though it is inconsistent about the figure. Treat it as unverified and ask the municipality.
- Stop-work notices that freeze your project mid-build.
- Forced removal at your cost.
- No utility connection and no completion certificate.
- Resale and insurance problems because the structure has no legal status.
Muscat Cargo describes a case where a cafe in Dubai Marina was given 48 hours to close after a complaint and then had to reapply for permits. Whatever the details, the lesson is consistent: approval first, build second.
Regulation Red Flags to Walk Away From
- A supplier who says “you do not need a permit”
- A quote that excludes consultant fees and approvals
- No mention of fire strategy or insulation specification
- Pressure to pay a full deposit before drawings are approved
- No written confirmation of who is responsible for the permit
Quick Regulatory Checklist
- Land rights confirmed in writing (title deed, usufruct or landlord consent)
- Plot use and zoning confirmed with the municipality or SUPC
- Accredited consultant appointed
- Soil report completed
- Fire strategy agreed
- SEWA connection route confirmed
- Permit issued before fabrication begins
How to Get Approval for a Container Home in Sharjah: Step-by-Step
The safest sequence is: land, consultant, drawings, permit, fabrication, inspections, completion. Skipping a step is how projects stall. Here is the roadmap in plain language.

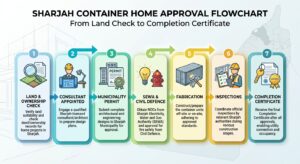

The 10-Step Approval and Build Roadmap
- Confirm land rights. Title deed, usufruct agreement or written landlord consent. Check any outstanding violations on the plot.
- Confirm plot use and limits. Ask the municipality or SUPC what the plot may be used for, plus setbacks, height and built-up limits.
- Appoint an accredited engineering consultant. Permit applications are submitted through a consultant office accredited by Sharjah Municipality, who also tracks comments and receives the permit certificate.
- Commission a site survey and soil report. These drive foundation design and drainage.
- Prepare drawings. Architectural, structural and MEP, including the container modifications, insulation build-up and fire strategy.
- Submit the building permit application on the municipality’s e-services portal. The consultant responds to review comments. Missing documents lead to rejection and resubmission.
- Obtain utility and safety approvals. SEWA for connections and any no-objection certificates, and Civil Defence where applicable.
- Start fabrication only after the permit is issued. The workshop builds the shell, cuts openings, reinforces, insulates and pre-fits services where possible.
- Transport, crane and install. Foundations are completed, units are lifted into place, aligned and welded or bolted to anchor plates.
- Complete inspections and obtain the completion certificate. Typical stages include foundation, frame, MEP and final inspection. Only then should you occupy the home.

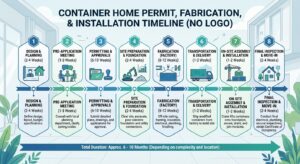

Realistic Timeline
These are planning ranges. Real timing depends on plot type, consultant speed and how complete your first submission is.
| Stage | Typical duration | What can slow it down |
|---|---|---|
| Land and zoning checks | 1 to 3 weeks | Unclear title, plot violations |
| Consultant, survey, soil report | 2 to 4 weeks | Site access, consultant workload |
| Drawings and design coordination | 3 to 6 weeks | Changing the brief mid-design |
| Municipality review and approvals | 2 to 8 weeks | Missing documents, comments to resolve |

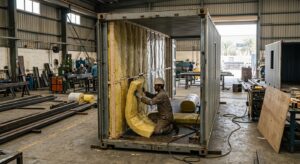

| Fabrication in workshop | 6 to 12 weeks | Steel supply, custom design, finishing scope |
| Foundations and site works (parallel) | 2 to 4 weeks | Weather, utilities trench |
| Installation and final connections | 1 to 3 weeks | Crane access, SEWA connection date |
| Inspections and completion certificate | 1 to 3 weeks | Failed inspection, snag list |
Total: roughly 4 to 9 months from first call to keys.
For context, one commercial source reports residential permit review in the range of 10 to 12 working days and a first technical review of 5 to 7 working days. Another Sharjah municipality guide says an inspection request is booked within two working days. These are best-case review times for complete files, not your total project timeline.
Documents Your Consultant Will Typically Ask For
- Title deed or usufruct or lease documents
- Owner’s ID and, for companies, trade licence
- Certified site survey showing plot boundaries
- Soil investigation report
- Architectural, structural and MEP drawings in PDF and CAD
- Structural calculations for the container modifications and foundation
- Manufacturer’s data for the container and key materials (insulation, cladding, glazing)
- Fire strategy and material fire ratings
- Master developer NOC, if the plot is in a community
- SEWA no-objection certificate, if near utility networks
Reported Cost of the Approval Process
Official fee schedules change, so confirm on the municipality portal. For orientation only, one commercial advisory source reports the following ranges.
| Item | Reported range (AED) |
|---|---|
| Permit application fee | about 750 (non-refundable) |
| Residential permit fee | about 2.50 per sq ft of approved area |
| Site survey | 2,000 to 5,000 |
| Engineering consultant | 10,000 to 60,000 |
| SEWA no-objection certificate | 1,500 to 3,000 |
| Civil Defence fire certificate | 500 to 2,000 |
Using those reported numbers, a 56 m2 (about 600 sq ft) two-container home would carry roughly AED 1,500 in area-based permit fees. The consultant, not the permit fee, is the main approval cost. Treat all figures as indicative until you hold a written quote.
Who Should Handle the Permit: You, the Consultant or the Supplier?
- The consultant is the official channel. They submit, respond to comments and receive the certificate.
- The supplier can help with fabrication drawings and coordination, and some offer turnkey packages including permits.
- You remain legally responsible as owner, so ask for copies of every submission and approval.
Get this in writing: who applies, who pays the fees, who attends inspections and who is responsible if a resubmission is needed.
Five Ways to Speed Up Approval
- Submit a complete file the first time. Incomplete submissions are returned.
- Use a consultant with recent Sharjah experience with prefabricated or steel structures.
- Freeze your brief before drawings start. Late changes cost weeks.
- Choose standard container sizes and conventional details.
- Book inspections promptly and have the site ready.
Container Home Cost in Sharjah: Realistic Budget Breakdown (AED)
A well-built, insulated and air-conditioned 40-foot container home in Sharjah typically lands between about AED 90,000 and AED 350,000, before land. The spread is huge because “container home” can mean anything from a basic guest pod to an architect-designed villa.
Read this first: the figures below are planning estimates compiled for this guide from typical UAE fabrication scope. They are not quotations and no supplier price list was used. Prices move with steel, labour and finish. Get at least three itemised quotes against the same drawings.
Cost by Quality Level (Single 40 ft High-Cube, about 28 m2 / 300 sq ft)
| Level | What you get | Planning range (AED) | Approx. per sq ft (AED) |
|---|---|---|---|
| Basic | One-trip container, essential insulation, split AC, simple bathroom, vinyl or tile floor | 90,000 to 130,000 | 300 to 433 |
| Standard residential | Better insulation, external cladding or shade, double-glazed windows, fitted kitchen and bathroom | 130,000 to 220,000 | 433 to 733 |
| Premium design | Architect design, custom joinery, premium glazing, decks, smart controls, high-end finishes | 220,000 to 350,000 | 733 to 1,167 |
These ranges exclude land, consultant and approval fees, and long-distance utility extensions.
Line-by-Line Budget for a Standard 40 ft Container Home
| Cost item | Planning range (AED) |
|---|---|
| New one-trip 40 ft high-cube container | 8,000 to 15,000 |
| Structural modifications, cutting, reinforcement, welding | 8,000 to 18,000 |
| Insulation, vapour control and internal lining | 12,000 to 25,000 |
| External cladding, roof shade and shading elements | 10,000 to 30,000 |
| Windows and doors (thermally broken, double glazed) | 8,000 to 20,000 |
| Electrical works and lighting | 6,000 to 12,000 |
| Plumbing, sanitary ware and bathroom fit-out | 8,000 to 18,000 |
| Air conditioning (sized by heat-load calculation) | 5,000 to 12,000 |
| Flooring, ceilings and painting | 8,000 to 18,000 |
| Kitchen and joinery | 8,000 to 25,000 |
| Transport, crane and installation | 4,000 to 10,000 |
| Foundations and site preparation | 8,000 to 20,000 |
| Subtotal (build only) | 93,000 to 223,000 |
Costs Outside the Build Price
These are the costs first-time owners forget:
| Item | Planning range (AED) |
|---|---|
| Consultant, drawings and supervision | 10,000 to 60,000 |
| Permit and approval fees, surveys, soil report | 5,000 to 15,000 |
| SEWA connections, trenching, septic or sewer link | 5,000 to 25,000 |
| Landscaping, boundary wall, parking, gate | 5,000 to 40,000 |
| Insurance during construction | 1,000 to 5,000 |
| Contingency (set aside 10 to 15 percent of build cost) | 9,000 to 33,000 |
Add-ons total roughly AED 35,000 to 180,000, depending on the plot. A common budgeting mistake is to compare a container shell price with a finished-home price. Always compare like for like: shell to keys, with approvals.
Cost Example: Two 40 ft Containers (About 56 m2 / 600 sq ft)
A two-container family home typically costs around 1.7 to 1.9 times a single unit, not double, because some costs (foundations, plot works, approvals, utilities) are shared.
- Build cost: about AED 220,000 to 420,000 for standard finishes
- Add-ons: about AED 50,000 to 200,000
- Indicative total: about AED 270,000 to 620,000, excluding land
If the number surprises you, remember that you are paying for engineering, insulation and compliance, not for steel boxes.
Are Container Homes Cheaper Than Conventional Construction?
Sometimes, but mostly in time and flexibility rather than in cost per square foot.
- Where containers can win: a small footprint, a fast build, repeatable units, a workshop-controlled quality and the ability to relocate.
- Where they lose ground: insulation, cladding and cooling cost more per square foot than in thick masonry walls, and engineering for cut openings adds fees.
- Where conventional wins: larger homes, multi-storey houses, and plots where authorities prefer familiar building methods.
Smart comparison method: ask for two quotes against the same brief, one for a container and one for conventional block or precast, and compare cost per usable square foot including approvals.
Running Costs and Maintenance
- Electricity for cooling. The largest ongoing cost. Good insulation and shading cut it dramatically.
- Repainting and coating. Plan to inspect and recoat the exterior every few years in coastal or humid conditions.
- Sealant and weatherproofing checks at roof edges, openings and joints every year.
- Corrosion inspection at the base, welds and cut edges.
- Pest and moisture checks under raised floors.
Hidden Cost Traps to Watch For
- “Shell only” quotes that exclude insulation, AC and electrical
- Unpriced foundation and crane access
- Late design changes after fabrication starts
- Cheap insulation that fails fire or condensation requirements
- No allowance for SEWA connection distance
- Warranty exclusions that void cover if you modify the unit
8 Practical Ways to Reduce Cost Without Cutting Quality
- Choose one 40 ft high-cube before expanding to multiple units.
- Keep plumbing in one wet wall to shorten pipe runs.
- Use standard window sizes instead of custom glazing.
- Spend on insulation and shade first, finishes second.
- Approve one fixed scope before fabrication.
- Buy new one-trip containers instead of repairing worn units.
- Bundle finishing trades with one coordinated contractor.
- Ask for phased payments tied to milestones, never full upfront payment.
Container Home Suppliers in Sharjah and the UAE: How to Find and Vet Them
Choose the supplier on documented capability, not on the cheapest quote. The UAE has container sellers, modular fabricators, design-and-build firms and finishing specialists. They are not the same thing, and mixing them up is the most common reason projects go over budget.
The Four Types of Supplier You Will Meet
| Supplier type | What they do | Best for | Watch out for |
|---|---|---|---|
| Container traders | Sell new, one-trip or used boxes | Owners with their own designer and contractor | No engineering, no insulation, no permit help |
| Modular fabricators | Convert containers in a workshop: cutting, welding, insulation, fit-out | Turnkey homes, offices, cabins | Quality varies widely between workshops |
| Design-and-build contractors | Handle design, approvals, fabrication and site works | Owners who want one point of responsibility | Higher price, but clearer accountability |
| Finishing specialists | Ceilings, cladding, coatings, flooring, decorative elements | Raising finish quality and thermal performance | Must be coordinated with the main contractor |
Where to Look
- Sharjah industrial areas, including Al Sajja. Steel fabricators and finishing trades are concentrated here, which helps when you need quick site visits.
- Specialist UAE container and modular companies. Several publish guides and project photos online, for example Arabian Containers, Green Boxtainer and Containers ME. These are examples of suppliers who appear in public search results, not endorsements and not verified by us.
- Referrals from consultants. A consultant who has pushed prefabricated steel buildings through Sharjah Municipality knows which workshops deliver compliant drawings.
- Visit completed projects. Nothing replaces standing inside a finished unit in July.
For context, What’s On reported in 2024 that container homes are a real product in Dubai, with builds including duplexes, ensuite bathrooms and multiple bedrooms. That shows the product exists locally. It does not replace your own due diligence.
12-Point Supplier Vetting Checklist
- Valid UAE trade licence with a relevant activity (fabrication, contracting or trading)
- Written scope that lists insulation, AC, electrical, plumbing and finishes line by line
- Container documentation: CSC plate, manufacturing date and condition report
- Engineering competence: named structural engineer, or a consultant who stamps the drawings
- Approvals track record: at least two permitted projects, with references you can call
- Insulation specification with fire rating, thickness and vapour control stated
- Welding and corrosion protection method: certified welders, coating system and warranty
- Warranty terms in writing, including what voids it
- Payment schedule tied to milestones, not a large upfront deposit
- Delivery and installation plan: crane, access, utilities, who does what
- Insurance for transport and installation
- After-sales support: who responds when the AC trips in August
10 Questions to Ask Every Supplier
- Have you delivered a container home (not only an office) that holds a completion certificate?
- Who prepares and submits the permit drawings?
- What exactly is the insulation build-up, and what is its fire rating?
- How do you handle condensation and vapour control?
- What is the AC capacity in tons for my unit, and how was it calculated?
- What is excluded from this quote?
- What happens if the permit comments require design changes?
- What is the delivery window, and what are the late-delivery terms?
- Can I visit the workshop during fabrication?
- What does the warranty cover, and for how long?
Supplier Comparison Scorecard
Score each supplier from 1 to 5 on the same criteria, then compare totals. Weighting guidance in the last column reflects what drives long-term satisfaction.
| Criterion | Supplier A | Supplier B | Supplier C | Suggested weight |
|---|---|---|---|---|
| Permit and approvals experience | High | |||
| Insulation and fire specification | High | |||
| Quality of completed projects | High | |||
| Transparent, itemised quote | High | |||
| Payment terms and warranty | Medium | |||
| Delivery timeline | Medium | |||
| Design flexibility | Medium | |||
| Price | Medium |
Red Flags in Quotes and Sales Talk
- “No permit needed.” Walk away.
- A single-line price for the whole home
- Stock photos instead of real project photos
- No named engineer
- Pressure to pay in full before drawings are approved
- “Insulation included” with no thickness, material or fire rating
- No site visit before quoting
Where Finishing Specialists Fit In
Most container supplier quotes treat finishing as an afterthought. Yet ceilings, wall linings, external cladding and coatings decide how the home feels and how well it handles heat. This is where a specialist adds value.
Al Jilani GRC, based in Al Sajja Industrial Area, Sharjah, is not a container supplier. It manufactures and installs architectural finishing elements, which is relevant to the finishing layer of a container build:
- GRC (glass fibre reinforced concrete) panels and decorative facade elements for external cladding concepts
- GRG (glass reinforced gypsum) for interior features and ceilings
- Gypsum board ceilings in standard, decorative and acoustic designs
- Painting contracting, including interior, exterior and epoxy coating work
- GRP (glass reinforced plastic) for moulded elements and features
The company lists ISO 9001:2015 and other certifications on its site. If you are comparing finishing options for your build, you can contact the team with your drawings and ask what is practical for a container-based structure. Always confirm weights, fixings and fire ratings with your structural consultant before specifying any cladding.
Beating the Heat: Insulation, Cladding, Ceilings and Floors for a Container Home in Sharjah
Steel conducts heat roughly two thousand times better than good insulation, so a container home lives or dies on its thermal envelope. In a Sharjah summer, with long stretches of 40 degree plus air temperatures and high humidity near the coast, an unprotected steel shell soaks up solar heat, then radiates it indoors all night.
A common failure pattern in hot-climate steel builds is simple: a beautiful interior, thin insulation, undersized AC and no shade. The owner moves in during winter, loves it, then calls the contractor in June.
The 6-Layer Strategy for a Cool Container Home
- Shade first. A raised roof canopy or shade structure stops sun from hitting the steel at all. This is the cheapest cooling you can buy.
- Reflective exterior finish. Light-coloured, high-reflectance coatings reduce solar gain on walls and roof.
- External or continuous insulation. Insulation outside the steel reduces thermal bridging.
- Internal insulation and lining. Fills the cavity, controls condensation and gives you a finished surface.
- High-performance glazing. Double glazed, low-emissivity glass with external shading.
- Correctly sized, efficient AC with controlled fresh air.
Insulation Options Compared
Thermal conductivity (lambda) shows how well a material resists heat flow. Lower is better. Values are typical published ranges; always use the manufacturer’s data sheet and the fire certificate for the exact product.
| Option | Typical lambda (W/mK) | Pros | Watch-outs |
|---|---|---|---|
| PIR or PUR rigid board | about 0.022 to 0.028 | Excellent performance per thickness, saves interior width | Check fire classification, seal joints carefully |
| Closed-cell spray polyurethane foam | about 0.025 to 0.032 | Seals gaps, adheres to steel, helps with condensation | Needs a certified installer and fire-approved product and cover |
| Mineral wool (stone or glass) | about 0.033 to 0.040 | Non-combustible, good acoustic performance | Needs more thickness and good moisture protection |
| EPS or XPS boards | about 0.029 to 0.038 | Low cost, easy to install | Fire behaviour and approval need checking |
| Reflective foil layers | Not a stand-alone solution | Useful as a radiant barrier next to an air gap | Do not rely on foil alone |
The UAE-focused guide from Arabian Containers also stresses that proper insulation is crucial in the UAE climate, citing spray foam or rigid foam boards, external cladding, a protective roof and shading elements.
Condensation: The Problem Nobody Mentions
In humid conditions, warm moist air meeting a cooled steel wall condenses. Left unmanaged, you get mould, rust and peeling finishes behind the lining.
- Specify a continuous vapour control layer on the warm side of the insulation
- Choose closed-cell or well-sealed insulation systems
- Use thermal breaks at framing and window frames
- Provide controlled ventilation (a kitchen extract and bathroom extract at minimum)
- Avoid cold spots by wrapping the full steel surface, including corners and the floor
Interior Space: What Insulation Does to Your Room
A 40 ft high-cube has an internal width of roughly 2.35 m. Add 75 to 100 mm of insulation and a lining on both sides, and the room narrows noticeably.
- Plan furniture around about 2.1 to 2.2 m of clear width
- Use slim, high-performance insulation where width matters
- Consider external insulation to preserve internal space
- Make use of height: a high cube gives you room for ceiling services and a more comfortable feel
Cladding and Facade Options
External cladding does three jobs: protects steel, improves insulation and defines how the home looks.
- Metal composite or aluminium panels: Clean modern look, lightweight
- Timber-look or composite slats: Warmth and shading, subject to fire and weather rating
- Cement-based facade panels: Durable and decorative. GRC (glass fibre reinforced concrete) is widely used in UAE facade work, and weights and fixings must be checked by your structural engineer
- Render over insulated board systems: Familiar finish that blends with surrounding villas
- Perforated screens: Provide shade and privacy while keeping airflow
If you want your container home to blend in with Sharjah’s architectural character, ask your designer about arches, screens and cornice details. Specialist manufacturers such as Al Jilani GRC produce GRC, GRP and GRG elements that can give a plain box a recognisably local look. Confirm structure, fixings and fire rating first.
Ceilings, Lighting and Interior Linings
A container is a long, narrow, low-feeling space. Good ceiling design changes that.
- Gypsum board ceilings create a flat surface and hide AC ducts, wiring and downlights
- Cove lighting and curved details soften the tunnel effect. GRG interior features can add architectural detail where the structure allows
- Acoustic ceiling options reduce the drumming noise of rain and wind on steel
- Light colours make the space feel larger
- Skylights or clerestory windows bring daylight into the centre of the unit
Flooring: Where Epoxy Makes Sense
Container floors are marine plywood on steel cross-members. For a home you will typically strip, treat and replace or overlay the floor.
- Treat or replace the original floor, which may carry chemical preservatives
- Add insulation under the finished floor, especially if the unit sits on piers
- Choose the finish: porcelain tile, engineered vinyl, polished screed or an epoxy coating
- Seal the edges where floor meets wall to avoid moisture ingress
Epoxy flooring gives a seamless, easy-clean, moisture-resistant surface, which suits kitchens, bathrooms, workshop-style units and commercial containers. Al Jilani GRC’s painting contracting service lists interior, exterior and epoxy coating work, so it is worth asking for a quote when you brief your flooring.
Exterior Coatings and Corrosion Protection
- Prepare the steel properly: remove rust, sandblast or abrade, then prime
- Use a marine-grade or industrial coating system with a stated warranty
- Protect cut edges and welds immediately after fabrication
- Seal roof penetrations such as AC pipes and vents
- Re-inspect annually, especially near the coast
Windows, Doors and Shading
Containers lose a lot of performance at openings.
- Choose thermally broken frames with double glazed, low-e glass
- Place larger windows on north or shaded elevations where possible
- Add external shading: overhangs, louvres, screens or pergolas
- Use insulated doors and seal all gaps
- Avoid big west-facing glass without shading
Air Conditioning and Ventilation
- Ask for a heat-load calculation. Do not accept “1 ton per 100 sq ft” as a design method.
- Choose inverter units to reduce running costs.
- Provide fresh air through controlled ventilation.
- Think about condensate drainage and where outdoor units sit in shade.
- Plan service access so technicians can reach equipment safely.
Designing and Building Your Container Home: Layouts, Build Sequence, Pros and Cons
Good container design works with the box instead of fighting it. The most successful homes use simple geometry, generous shading and a layout that respects the 2.35 m internal width.
Five Layouts That Work in Sharjah
- Single 40 ft studio. Open living and sleeping area, kitchenette, bathroom at one end. Ideal for a guest unit, rental or compact home.
- Single 40 ft one-bedroom. Bathroom and utility at one end, bedroom at the other, living and kitchen in the centre.
- Side-by-side double (2 x 40 ft with an opened wall). Creates a wider living space of roughly 4.7 m, which feels like a normal room. Needs careful structural design.
- L-shaped or U-shaped courtyard layout. Three or four containers around a shaded courtyard. Excellent for privacy and cooling, and a good fit with local housing traditions.
- Two-storey stacked layout. Maximises a small plot, but brings structural, fire and approval complexity. Start with an experienced consultant.
Design Principles for a Hot, Humid Climate
- Orient the long side north-south where the plot allows, reducing east and west sun on the long walls
- Raise the unit slightly off the ground for airflow and drainage
- Add a shaded outdoor room. A covered terrace roughly doubles the usable living space in winter
- Use cross-ventilation with openings on opposite sides for winter and shoulder months
- Keep wet areas together to reduce plumbing cost
- Plan storage early. Container homes have little hidden space
- Respect privacy. Sharjah’s culture values it, so use screens, courtyards and window placement carefully
Foundations: Do Not Cut Corners
| Foundation type | Best for | Notes |
|---|---|---|
| Concrete pad or pier supports | Single units, level sites | Fast and cost-effective. Needs correct levelling and anchoring |
| Strip footings | Multiple units, heavier cladding | Good load distribution |
| Raft slab | Poor soil, stacked units | Higher cost, high stability |
| Steel plinths on piles | Soft or sandy ground | Designed from the soil report |
Your soil report and structural engineer decide the choice. Sandy or reclaimed ground and high groundwater are not uncommon in the region.
The Build Sequence from Workshop to Handover
- Design freeze and permit. No fabrication before approval.
- Container procurement and inspection. Verify condition, plates and dimensions.
- Workshop fabrication. Cut openings, add frames, weld reinforcements, treat steel.
- Insulation and rough-in. Install insulation, vapour layer, electrical conduits and plumbing runs.
- Internal finishing. Lining, ceilings, flooring, joinery, sanitary ware.
- Site foundation built in parallel while the shell is in the workshop.
- Transport and crane lift. Plan the route, permits, crane radius and ground bearing.
- Placement and anchoring. Align, level and fix to the foundation.
- Final connections. SEWA supply, water, drainage, AC commissioning.
- Cladding, coatings, landscaping and handover testing.
Pros and Cons of a Container Home in Sharjah
| Advantages | Disadvantages |
|---|---|
| Fast construction because fabrication runs alongside site works | Heat management needs more design care than masonry |
| Quality control in a workshop environment | Approvals are case by case with no dedicated container code |
| Modular growth: add units later | Financing and resale can be harder with unconventional structures |
| Strong steel structure when designed well | Narrow interior width limits layouts |
| Relocatable in many designs | Corrosion needs ongoing care |
| Lower waste and a reuse story | Insulation and cladding add real cost |
| Distinctive design with finishes and decks | Neighbour and master-developer rules may restrict use |
Best Uses for Container Structures in Sharjah
- Guest house or majlis on a family plot
- Farm or retreat cabin with a shaded deck
- Rental studio or staff accommodation on suitable land
- Site office for contractors
- Cafe, kiosk or pop-up retail on commercial plots
- Clinic, showroom or small workshop
- Student or workforce accommodation where zoning permits
A useful rule: start with a use that has a clear permitted category. A site office on a commercial or industrial plot is typically simpler than a permanent family home on a villa plot.
Alternatives to Consider
- Prefabricated steel-frame or light-gauge steel homes: more design freedom, standard insulation systems, familiar to authorities
- Precast concrete modules: thermal mass and durability, heavier transport
- Conventional block-built extension or annex: often the easiest approval on a villa plot
- Glamping-style cabins: lighter structures for short-stay hospitality
If your primary goal is speed and modularity, containers can be excellent. If your primary goal is the lowest-risk approval on a residential plot, ask your consultant honestly which method fits best.
12 Costly Mistakes to Avoid
- Buying the container before confirming land rights and approvals
- Skipping the consultant and relying on the supplier’s sketches
- Underspecifying insulation to hit a price
- Ignoring condensation and vapour control
- Undersizing the AC or ignoring shade
- Cutting too much steel without structural design
- Ignoring fire safety details and material certificates
- Using a used container with unknown history and chemical floors
- Underestimating the SEWA and drainage route
- Changing the design after fabrication starts
- Paying most of the price upfront
- Forgetting maintenance of coatings, sealants and welds
Safety, Security and Insurance
- Security: Steel is strong, but doors, windows and locks decide security. Specify quality frames and locks
- Lightning and surge protection are sensible on exposed rural sites
- Insurance: Ask insurers early whether they will cover a container structure and what documents they need
- Documentation: Keep the permit, drawings, certificates and warranties together. You will need them for resale, insurance and any future extension
Image Placement Plan with ALT Text (For Your Editor or Web Developer)
Use one image roughly every 500 to 700 words, and give every image a descriptive file name, ALT text and a short caption. The first ten placeholders already appear inside the article above. Images 11 and 12 are extra suggestions.
| # | Where to place it | What the image should show | Suggested file name | ALT text |
|---|---|---|---|---|
| 1 | Directly under the intro, before Quick Answer | Hero shot of a finished container home with shaded terrace | container-home-sharjah-hero.webp | Modern two-container home in Sharjah with shaded terrace and insulated cladding |
| 2 | After the container sizes table | Labelled size comparison of 20 ft, 40 ft and 40 ft high-cube | container-sizes-20ft-40ft-high-cube.webp | Size comparison of 20 ft, 40 ft and 40 ft high cube shipping containers used for homes in the UAE |
| 3 | After the authorities table in Regulations | Approval flowchart from land check to completion certificate | sharjah-container-home-approval-flowchart.webp | Sharjah container home approval flowchart from land check to completion certificate |
| 4 | After the realistic timeline table | Timeline infographic of the eight project stages | container-home-permit-build-timeline.webp | Timeline infographic of container home permit, fabrication and installation stages in Sharjah |
| 5 | After the cost-by-quality-level table | Basic, standard and premium finish comparison | container-home-cost-levels-sharjah.webp | Basic, standard and premium container home finish levels compared in Sharjah |
| 6 | In the Suppliers section, after the supplier types table | Workshop fabrication and insulation in progress | container-home-workshop-fabrication-sharjah.webp | Container home shell being fabricated and insulated in a Sharjah industrial workshop |
| 7 | After the 6-layer cooling strategy | Wall section diagram with insulation, vapour barrier and shade | container-home-insulation-wall-section.webp | Wall section of an insulated container home showing steel shell, insulation layers and roof shade for Sharjah heat |
| 8 | In the ceilings and linings subsection | Interior with gypsum ceiling and cove lighting | container-home-interior-gypsum-ceiling.webp | Interior of a container home in Sharjah with gypsum ceiling, cove lighting and white insulated walls |

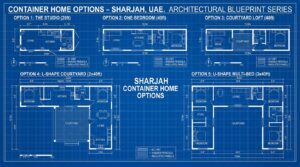

| 9 | After the five layouts list | Plan drawings of studio, one-bedroom and courtyard layouts | container-home-floor-plans-sharjah.webp | Floor plan options for container homes in Sharjah including studio, one-bedroom and courtyard layouts |
| 10 | After the build sequence list | Crane placing a module onto foundations | container-home-crane-installation-sharjah.webp | Crane placing a prefabricated container home module onto concrete foundations in Sharjah |
| 11 | After the line-by-line budget table | Doughnut or bar infographic of the cost split by item | container-home-cost-breakdown-aed.webp | Cost breakdown chart of a 40 ft container home in Sharjah in AED by building item |
| 12 | In the conclusion, above the call to action | Finished home at dusk with warm interior lighting | finished-container-home-sharjah-evening.webp | Finished container home in Sharjah at dusk with warm interior lighting and shaded terrace |
Image tips for SEO and AI search:
- Use WebP at under 150 KB where possible, and lazy-load every image except the hero
- Write ALT text that describes the image, not a keyword list
- Add captions where the image explains a concept (flowcharts, wall sections)
- Add the primary keyword naturally in the hero and one or two other ALT texts only
- Use original photos or commissioned graphics where you can. They build Experience signals better than stock images
Before You Sign Anything: The Final Decision Checklist
- I hold written rights to the land (title deed, usufruct or landlord consent)
- The plot’s permitted use allows my intended container structure
- An accredited consultant is appointed and has seen the site
- My supplier quote is itemised and covers insulation, AC, electrical and plumbing
- Fire strategy and insulation fire ratings are documented
- The permit is issued before fabrication starts
- Payments are tied to milestones
- SEWA connection and drainage routes are confirmed
- I have a 10 to 15 percent contingency
- I have visited at least one completed container project
Conclusion: Is a Container Home in Sharjah Right for You?
A container home in Sharjah is a smart choice when you value speed, modularity and a distinctive design, and when you treat it as a fully engineered, fully approved building. It is a poor choice when it is bought as a shortcut around permits or around good insulation.
Here is the practical summary:
- Regulations: no dedicated container law is published, so plan for a full building approval through an accredited consultant and Sharjah Municipality.
- Land: confirm ownership or usufruct rights and the plot’s permitted use before spending on design.
- Costs: budget about AED 90,000 to 350,000 for a single finished 40 ft unit, plus approvals, utilities and site works.
- Suppliers: choose on permit track record, insulation specification and itemised scope, not on the lowest price.
- Comfort: shade, insulation, vapour control, glazing and correctly sized AC matter more than any finish.
If you are planning the finishing layer of your build, including ceilings, facade elements, painting or epoxy coatings, you can explore Al Jilani GRC’s services, browse the project gallery for finishing inspiration, or contact the team in Al Sajja, Sharjah with your drawings. Bring your consultant’s structural and fire requirements so any cladding or interior elements are specified correctly from the start.
Frequently Asked Questions
1. Are container homes legal in Sharjah?
Yes, in principle. A container home is legal in Sharjah when it is approved as a building: you hold land rights, the plot’s zoning allows the use, an accredited consultant submits stamped drawings, Sharjah Municipality issues a permit, and SEWA and Civil Defence requirements are met. There is no published exemption from permits, and unapproved structures risk fines, stop-work notices or removal.
2. How much does a container home cost in Sharjah?
As a planning estimate, a finished, insulated and air-conditioned 40 ft container home costs about AED 90,000 to 350,000 before land, depending on the finish level. Add roughly AED 35,000 to 180,000 for consultant fees, approvals, utility connections, site works and contingency. A two-container family home typically totals about AED 270,000 to 620,000, excluding land.
3. Do I need a permit to build a container home in Sharjah?
Yes. Treat every container home as a building that needs a permit. Applications go through Sharjah Municipality’s e-services via an accredited engineering consultant. Start fabrication only after the permit is issued, then pass inspections and obtain a completion certificate before you move in.
4. Can foreigners build a container home in Sharjah?
Only if they hold lawful rights to the land. Under Sharjah Law No. 2 of 2022, foreign freehold ownership is generally limited to areas and projects designated by the Sharjah Executive Council, and long-term usufruct has been a traditional route. Confirm your rights with a lawyer and the municipality before buying a container or paying design fees.
5. Are container homes suitable for the UAE’s heat?
Yes, if they are engineered for it. Steel conducts heat, so a comfortable container home needs shade, continuous insulation, vapour control, low-e double glazing and a properly sized air conditioner. Without these, interiors overheat in summer and condensation can cause rust and mould. Insulation is the most important line in the budget.
6. How long does it take to build a container home in Sharjah?
Plan for about 4 to 9 months from first design to handover. That includes roughly 6 to 13 weeks for land checks, consultant work and drawings, 2 to 8 weeks for municipality review, 6 to 12 weeks for workshop fabrication, and a few weeks for installation, connections and inspections. Foundations are built in parallel with fabrication.
7. Where can I buy a container home in Sharjah?
Buy from a licensed UAE modular fabricator or design-and-build contractor, not only from a container trader. Look in Sharjah’s industrial areas such as Al Sajja, ask consultants for referrals and visit completed projects. Vet each supplier on trade licence, container documentation, permit track record, insulation specification, warranty and milestone-based payment terms.
8. How long does a container home last?
With good corrosion protection and maintenance, steel container structures are often cited as lasting 25 to 50 years, though no UAE-specific figure applies. Lifespan depends on coastal exposure, coating quality, sealed welds and cut edges, drainage and regular inspection. Annual checks at the base, roof edges and openings are the best investment.
